Tag: HSR economics

  • New report

    The Report Counts the Benefits. It Does Not Show the Bill.

    ALTO’s new economic report says the high-speed train would add $24.5 billion a year to Canada’s economy. Read closely, it also tells you what it did not look at: the fare, the cost of building the railway, and whether the roads we already need would still have to be paid for.

    ⚠ The Document Under Examination

    On November 19, 2026, ALTO released An Economic Ambition: How Alto’s High-Speed Train Can Transform Canada’s Economy, an 89-page report written for ALTO by the Québec consulting firm Aviseo. CBC News reported on it the next day. CBC News

    Page numbers on this page refer to that report, so every point can be checked against it.

    In Short

    The big number is not new. The $24.5 billion figure is the same one ALTO published in June. The report says it comes from modelling done in 2024, which has since been revised. The revised results are promised for 2027.

    The report says it is not a cost-benefit analysis. It does not include what the railway would cost to build or run, and it does not consider the fare, even though it says the fare decides how large the benefits would be.

    The “cost of doing nothing” is not a saving. The report itself says the road spending already planned would not automatically be avoided if ALTO is built. For the many towns between stations, the roads are still needed either way.

    Download
    Not a Cost-Benefit Analysis — Full Brief (PDF)
    Section-by-section reading of An Economic Ambition, with tables, page references and calculations
    Download PDF
    The Headline Figure

    The same numbers, already revised

    The report repeats the figures ALTO first published in June 2026: a $24.5 billion yearly boost to Canada’s economy (its gross domestic product, or GDP), made up of $21.0 billion from higher productivity, $2.7 billion from more people working, and $0.8 billion from international tourism. The jobs figures are also the same: 50,000 during construction and 5,000 to run the railway.

    $24.5B
    yearly GDP gain claimed, unchanged since June 2026
    Report, p.5 and p.63
    0
    times the $60–90 billion construction cost appears in 89 pages
    Initiative search of the report text
    1,470
    extra intercity commuters in the report’s own estimate
    Report, p.59

    Two notes in the report (p.5 and p.63) say these results come from modelling carried out in 2024. They say the model and its assumptions have since been updated, and that the new results will be released in 2027. So the report published in November 2026 presents figures that its own authors describe as already revised, without showing the revision.

    The report also says (p.64) that the 50,000 construction jobs and 5,000 operating jobs “were not taken into account in modelling.” No source is given for them.

    The 1.1% Claim

    A percentage that depends on what you divide by

    ALTO has described the $24.5 billion as about 1.1% of Canada’s economy. In July, our brief Two Point Two Trillion showed that against the size of today’s economy, $24.5 billion is closer to three-quarters of one percent.

    The new report reaches 1.1% a different way. It divides $24.5 billion by a measure of Canada’s economy that is smaller than the usual headline figure, and that is counted in a different year’s dollars from the $24.5 billion itself. The report does not explain the change.

    What $24.5 billion is divided bySize of economyShare
    The measure used in the new report (2025, by industry, 2017 dollars, excluding sales taxes)$2,330B1.05%
    Canada’s economy, first quarter of 2026, as revised by Statistics Canada$3,328B0.74%
    Canada’s economy, second quarter of 2026 (latest published)$3,438B0.71%

    Shares are Initiative calculations. The first denominator is quoted from the report (p.63); the other two are Statistics Canada figures for GDP at market prices, at annual rates (Table 36-10-0103-01).

    The Fare

    The report says the fare matters most, then sets it aside

    The report is clear that the ticket price decides how much good the train does. A service that is too expensive, it says, would carry fewer people and deliver fewer benefits (p.9). It says capturing older travellers will “depend on the fare chosen” (p.32), and that the project’s value depends “as much on its performance as on its affordability” (p.40).

    Then, on p.9, it says the fare is not taken into account, because fare information “remains unknown.”

    But the report still uses ALTO’s ridership forecast: 24 million passengers a year by 2055, and rail’s share of Montréal–Toronto trips rising from 10% to 40%. A ridership forecast cannot be made without assuming a ticket price. That price has never been published. Our August brief Three Claims, One Fare explains why so much of ALTO’s case rests on this one unpublished number.

    The Price Tag

    The benefits are counted. The cost is not shown.

    ALTO’s own estimate of the construction cost is $60 to $90 billion, and CBC reports that the federal budget watchdog has said it could rise further. That figure does not appear anywhere in the 89-page report. The report says only that building the railway “requires significant investment” (p.35) and “incurs costs” (p.77).

    This follows from what the report says it is: not a cost-benefit analysis (p.9). The costs of building and running the railway are deliberately left out (p.62). That is a legitimate choice for a study of how benefits arise. It does mean the report cannot tell you whether the benefits are worth the cost.

    The clearest example is government revenue. The report says governments would collect $6.4 billion more in taxes each year once the train is running: $2.6 billion federal, $2.1 billion Ontario, $1.6 billion Québec (p.66). What it would cost governments to get there appears as a single sentence: financing costs “would likely be borne nationally.”

    The “Cost of Doing Nothing”

    The roads still need paying for, with or without ALTO

    CBC’s coverage reported Aviseo’s argument that communities along the route would need to invest “something like $50 billion” in roads, airports and railways without ALTO. As Aviseo’s co-founder put it: “There’s a cost of doing nothing.” The report’s own pages point the other way.

    The report says the planned road money would not be saved

    It lists Ontario’s $27.4 billion highway plan and Québec’s $35.7 billion road budget, then states that these “are not expenditures that would automatically be avoided thanks to Alto” (p.36). No savings on any road or airport project are estimated anywhere in the report.

    Most of that money is for fixing roads we already have

    Of Québec’s $35.7 billion, the report shows $31.6 billion is for maintaining existing roads (p.36), about 89% (Initiative calculation). A rail line does not repave a highway or replace a bridge.

    Most traffic jams are inside the cities, not between them

    The report itself says most congestion in the corridor comes from people commuting within the big cities, and that high-speed rail “would therefore not resolve urban congestion” (p.30).

    The $50 billion is not explained

    The report’s summary says needs “could exceed $50 billion” by 2050 (p.3); the body says “$50 billion per year by 2050” (p.37). One reads as a total, the other as a yearly amount. The only source given is Aviseo itself, and no calculation is shown.

    Towns Between Stations

    What it means for communities without a stop

    ALTO plans seven stations: Québec City, Trois-Rivières, Laval, Montréal, Ottawa, Peterborough and Toronto (p.28). A Kingston station is being assessed but is not in any of the report’s figures (p.27). Most communities along the corridor get no stop.

    What the report says

    Benefits depend on getting to a station A town without a stop gains only through its access to stations and the wider transportation network (p.25, p.51).
    Spillovers may reach about 110 km Based on studies of stations in other countries (p.51).
    About 6.8 million car trips a year shift to the train by 2055 From ALTO’s own forecast (p.35).

    What that means on the ground

    Getting to a station means driving From Cobourg, Belleville, Napanee, Gananoque, Brockville, Cornwall or Smiths Falls, the way to an ALTO station is the existing road network.
    Trips between these towns gain nothing Travel to a regional hospital, college or job between towns without stations is not served by the line at all.
    The shift is small next to the growth The report expects about 35 million more trips a year by 2059 (p.35). The 6.8 million shifted car trips are roughly a fifth of that (Initiative calculation; the two figures are not counted in exactly the same way).

    On the report’s own figures, the road spending it describes is needed whether ALTO is built or not. The real comparison is ALTO plus that spending, not ALTO instead of it.

    Other Things Worth Knowing

    Smaller points in the report

    “36% of the workforce” becomes 1,470 commuters

    The report says ALTO would bring together labour markets holding 36% of Canada’s workers (p.4). Its one worked estimate finds about 1,470 extra people commuting between station cities (p.59). It adds that Ontario and Québec workers move between provinces less than anyone else in Canada, partly because of language (p.60).

    Tourism: mostly money moving around

    The report says much of the extra domestic tourism would be spending shifting from one Canadian destination to another, not new spending (p.64). Only international visitors count in its $0.8 billion figure.

    Freight and VIA Rail point in opposite directions

    The report says freight benefits come from VIA passengers moving to the high-speed train, freeing track for freight (p.33). It also says ALTO’s value will be “highly dependent” on connecting with VIA Rail’s network (p.74). For towns that rely on VIA, the two statements depend on opposite outcomes.

    The success stories are much denser

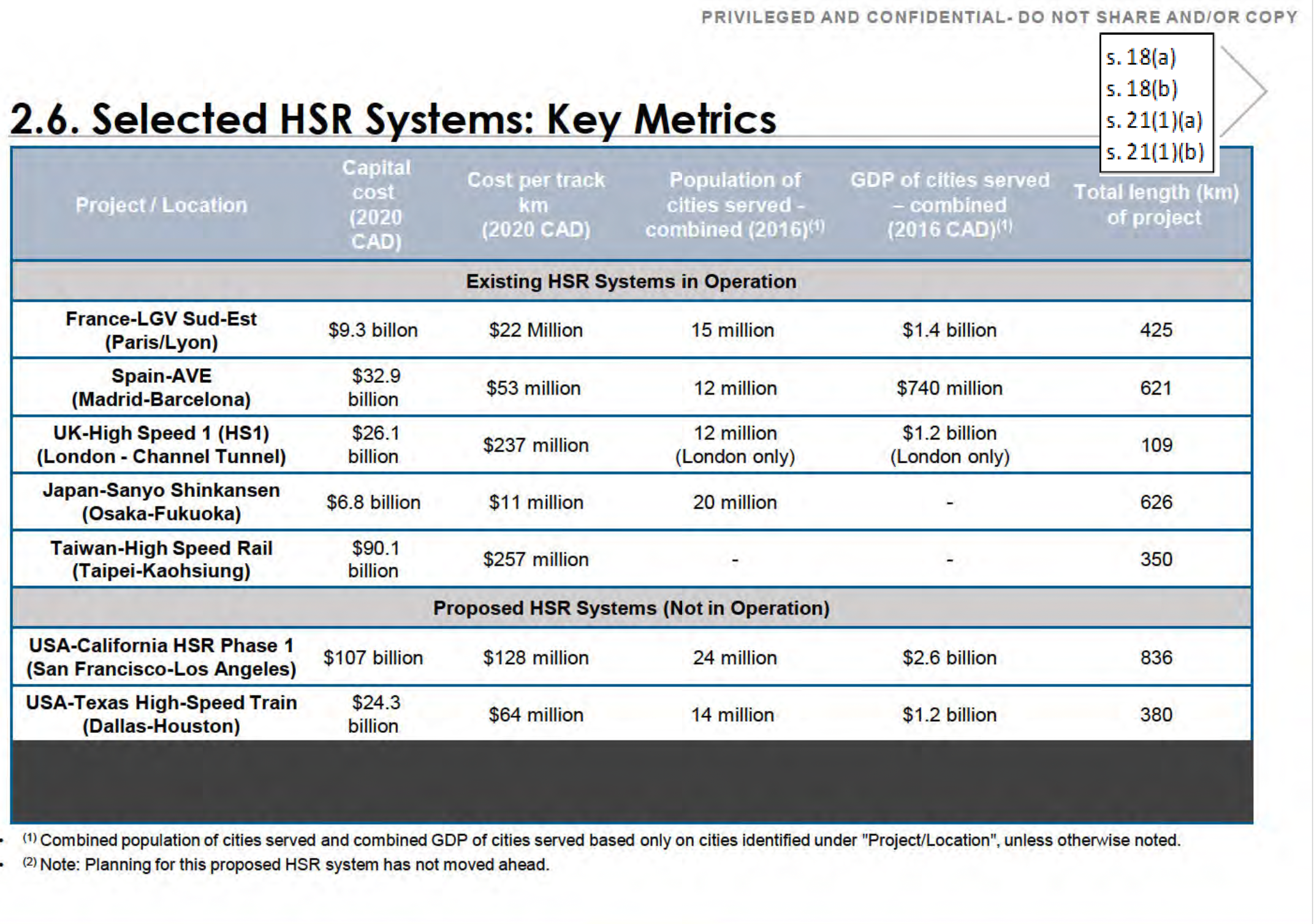

    The report compares ALTO with famous lines abroad. Using its own population and length figures, Tokyo–Osaka serves about 118,600 people per kilometre of line, Seoul–Busan about 43,500, and ALTO about 17,000 (Initiative calculation from pp.13, 17, 28 and 29).

    In the Report’s Own Words · November 2026

    What the report says it does not do

    Not included
    Costs and risks. It is not a cost-benefit analysis and does not consider risks or negative effects (p.9).
    Not included
    The fare. The fare decides the size of the benefits, and is not taken into account (p.9).
    Superseded
    The headline results. They come from 2024 modelling, since revised; new results are due in 2027 (p.5, p.63).
    Not avoided
    Planned road spending. It would not automatically be avoided thanks to ALTO (p.36).
    Not resolved
    City congestion. Most congestion is inside the cities, which high-speed rail would not resolve (p.30).
    Limited
    Commuting. About 1,470 extra commuters, and provincial barriers may limit even that (pp.59–60).

    Set side by side, the report’s own statements support a narrower reading than its title. ALTO has said it will publish a business case early in 2027. That is where the costs, the fare and the revised modelling would need to appear together.

    Status of the Figures

    Figures attributed to a source are quoted from the named published document, with page numbers, and can be checked there. All other figures are Initiative calculations from those inputs and are marked as such. Where ALTO or its consultants have not published a figure, such as the fare, the revised modelling, or the method behind the $50 billion projection, this page says so rather than guessing. No claim is made about why any figure was or was not published.

    Download Full Brief
    Not a Cost-Benefit Analysis (PDF, 7 pages)
    Full reading of An Economic Ambition with tables, page references and Initiative calculations
    Download PDF
    Sources

    Primary documents and statements

    1.
    Aviseo Consulting for Alto, An Economic Ambition: How Alto’s High-Speed Train Can Transform Canada’s Economy, November 19, 2026.
    2.
    CBC News, “Alto-backed study predicts major economic gains along proposed rail corridor,” November 20, 2026. cbc.ca
    3.
    Alto, Canada’s Moment: The Economic Opportunity of High-Speed Rail, August 2026.
    4.
    Statistics Canada, Table 36-10-0103-01, Gross domestic product, income-based, quarterly; released in The Daily, May 29 and August 28, 2026. statcan.gc.ca
    5.
    ALTO HSR Citizen Research Initiative, Two Point Two Trillion (July 2026) and Three Claims, One Fare (August 2026).
  • The options nobody priced

    The Option Nobody Priced

    ALTO’s same-day reply to the UPA’s existing-corridor study, measured against ALTO’s own published record.

    ⚠ Same-Day Response: ALTO Replies Within Hours

    On November 12, 2026, the Union des producteurs agricoles released a study by Vision Transport estimating that the existing Québec City–Toronto rail corridor could be modernised for about $11 billion, or $24–30 billion with additional crossing work and electrification. Vision Transport

    At 2:26 p.m. the same day, ALTO issued a formal French-language release rejecting the approach. The release contained no new cost figure, no benefit-cost ratio, and no costing of an upgrade to the existing corridor. For a comparison of high-frequency and high-speed rail, it gave a contact email address. Newswire

    Later that afternoon, ALTO’s CEO Martin Imbleau told The Canadian Press the proposal was “unfeasible” and that if it were feasible it would have been done decades ago. On the Québec radio programme La commission, he said ALTO cannot build a crossing for every farm, put the Montréal–Ottawa segment at just under 2,000 properties, including 500 or 600 agricultural owners, and offered to resume talks with the UPA without a confidentiality agreement. Canadian Press / L’actualité

    Critical Finding

    ALTO’s central claim, that high-speed rail would generate about five times the economic benefit of high-frequency rail, compares high-speed rail with a new $45–75 billion, 200 km/h railway that no one has proposed. The option the study actually puts forward, modernising the corridor that already exists, has not been costed or appraised by ALTO in any published document.

    On ALTO’s own published table, “five times” holds on one row only. On the row a standard transport appraisal is built on, direct benefits to travellers, high-speed rail delivers 1.47 times the slower option’s benefits. ALTO’s freight objection describes how the corridor is run today, not a physical limit, and ALTO’s own freight consultant describes the alternative: significant investment in the existing corridor.

    The reply asserts the conclusion of a comparison ALTO has not published. The farm associations’ request was for that comparison.

    Download
    The Option Nobody Priced — Full Brief (PDF)
    ALTO’s November 12 reply and the CEO’s interviews, claim by claim, against Canada’s Moment, ALTO’s freight study and the Vision Transport report
    Download PDF
    What Was Released

    A study of the corridor that already exists

    The Vision Transport study, prepared by Vincent Duguay with an expert opinion from Pierre DuSablon, a track engineering consultant who formerly ran CN operations between Montréal and Québec City, does not propose a new railway. It asks how fast a passenger train could run on the tracks that already exist if they were modernised, and what that would cost. Its answer rests on five actions: a second track on the 37% of the corridor that is single-track today; in-cab train control allowing 177 km/h; a standing power for the Canadian Transportation Agency to set train priority in favour of passengers; full gates at level crossings in the faster sections; and tilting trains on curves. Vision Transport

    ~$11B
    five actions on the existing corridor, 20% contingency included
    2025 dollars; $24–30B with all options
    6h51
    Québec City–Toronto with all 22 stations served, down from 8h50 today
    6h00 as an express
    924
    existing level crossings kept open, 569 of them private or farm crossings
    none required to close

    On the upgraded corridor, Montréal–Toronto would take 4h14 with all stops or 3h42 as an express, against 5h18 today and ALTO’s announced 3h. Montréal–Québec City would take 2h26, or 2h08 express, against 3h22 today. Every time includes a 10% scheduling cushion. The study attributes almost half of the 120 minutes saved end to end to fixing how passenger trains share the line with freight, rather than to higher speed.

    ALTO’s Release

    What the reply says, and what it brings

    ALTO’s release, Alto réaffirme l’importance du train à grande vitesse pour le Canada et ses engagements envers le milieu agricole, makes four points: freight priority rules out more passenger trains on CN, CPKC and CFQG track; high-speed rail would cut travel times about 50% and generate about five times the economic benefit of high-frequency rail ($24.5 billion a year in added GDP against $4.9 billion); about twenty countries, including France and Morocco, have invested in fast passenger rail; and ALTO restates its five commitments to farmers.

    The release links ALTO’s economic-benefits analysis, its June 2026 consultation report, its rural commitments page and its property-acquisition page. It does not link a comparison of high-frequency and high-speed rail. For that comparison, it provides an email address.

    In the release, ALTO’s president and CEO Martin Imbleau says the UPA has chosen to stop talking to ALTO. The public record shows that five farm organisations met on June 4, 2026 to consider ALTO’s invitation to sign a collaboration agreement and declined to sign it, and that the UPA, OFA and CFA have since asked Ottawa to release the analyses behind the choice of high-speed rail and to commission an independent comparison. OFA   Radio-Canada

    Claim by Claim

    ALTO’s reply against its own published record

    Each claim in the release, and in the CEO’s interviews with The Canadian Press and on radio the same afternoon, is set below against what ALTO and its commissioned consultants have already published. Radio remarks are from an app-assisted English translation posted by Stone Mills Against Alto; all interview remarks are translations from French.

    What ALTO’s Release SaysWhat the Published Record Shows
    1. High-speed rail generates about five times the economic benefit of high-frequency rail: $24.5 billion a year in added GDP against $4.9 billion.The comparison appears in ALTO’s Canada’s Moment, Table 2. The “high-frequency rail” it prices is a new 200 km/h railway costing $45–75 billion, a figure that carries no footnote or source. That is not the $11–30 billion existing-corridor option the study proposes. On the same table, direct benefits to travellers are $49.5 billion against $33.6 billion: 1.47 times, not five.
    Status:Holds on one row, against a different option
    2. Passenger trains cannot be added to CN, CPKC and CFQG track because freight has priority, and slowing freight would harm exporters including farmers; a new network is needed.Freight priority on the corridor is a default, not a law: no G7 country gives freight priority over passengers in statute. ALTO’s own freight study states ALTO “is not assumed to result in the discontinuation of local passenger rail services”, so ALTO’s plan keeps passenger trains on the freight line. The same study says accommodating freight growth without degrading passenger service “would imply significant investments in the absence of Alto.” The release gives no figure for the harm to exporters.
    Status:Describes today’s rules, not a physical limit
    3. High-speed rail would cut travel times by about 50%.On ALTO’s announced times, Québec City–Toronto falls from 8h50 to about 4h30, a 49% cut. Those times are spreadsheet estimates: the government’s own journey-time record shows only the 177 km/h case was simulated. ALTO has not said whether they include a scheduling margin, and they run between seven stations on a new alignment, none on the existing VIA line between Montréal and Québec City or through Kingston.
    Status:Holds on estimates, without qualification
    4. About twenty countries have invested in fast passenger rail, including France and Morocco.Morocco’s Al Boraq runs 186 km on a new high-speed line, then 137 km on the upgraded existing line into Casablanca at 160 km/h. It is an example of new construction combined with the existing corridor. The release does not say so.
    Status:Cited example is a hybrid
    5. ALTO restates its five commitments to farmers: limiting impacts, negotiated agreements, fair compensation, maintaining farm access through safe crossings, and supporting succession.Above 201 km/h a railway can have no level crossings at all, and Canadian rules already prohibit any new crossing on a line above 177 km/h. Every farm crossing on a 300 km/h alignment becomes a structure or a closure. On radio the same day, ALTO’s CEO said ALTO cannot build a crossing for every farm and that detours are “possible, even probable,” with compensation for decades of lost production; how that would be calculated has not been published. The existing-corridor option keeps all 924 crossings open. The release does not address the difference.
    Status:Difference between options not addressed
    6. “The UPA has chosen to stop talking to us.” The CEO told The Canadian Press he had never heard the confidentiality criticism before that morning, and that it was “absolutely not the reason” discussions broke down.Five farm organisations declined ALTO’s collaboration agreement on June 4, 2026, stating that signing would not be in their members’ best interests and citing the need for greater transparency and open communication with their memberships. The UPA, OFA and CFA have since asked for the analyses behind the choice of high-speed rail and for an independent comparison. The CEO’s offer to continue working with the UPA without a confidentiality agreement, and his statement that he needs the UPA’s members to help design crossings and detours, are new, and a constructive step if taken up.
    Status:Request for analysis not answered
    7. “A TGF doesn’t exist” and the concept is “unfeasible.” On radio, the CEO described high-frequency rail as a conventional train that goes a little faster. To The Canadian Press, he said that if it were feasible it would have been done 40, 30, 20 or 10 years ago, and that Ottawa’s original high-frequency project used new tracks independent of freight.ALTO began as VIA HFR–VIA TGF, the Crown subsidiary created to develop high-frequency rail. ALTO’s release the same day assigns high-frequency rail an annual GDP effect of $4.9 billion, and its Canada’s Moment report prices it at $45–75 billion. The CEO’s own account confirms that the high-frequency project ALTO compares against was a new line, not the existing-corridor option. No published ALTO analysis shows that option to be infeasible; ALTO’s own freight consultant refers to “expansions to the CN corridor that may no longer be needed due to Alto being built”, an investment it treats as one ALTO would avoid, not one that cannot be made.
    Status:Inconsistent with ALTO’s own release and freight study
    8. A second track would mean closing the CN and CP lines for several years and buying “thousands and thousands of properties”, because the existing right-of-way is too narrow in most places. Electrifying lines used by double-stacked trains would be prohibitively expensive.None of the three statements is accompanied by a figure: no closure period, no property count, no electrification cost. The study’s core $11 billion package is diesel; electrification is an optional add-on. For comparison, ALTO’s CEO put the Montréal–Ottawa first segment of the new line at just under 2,000 properties.
    Status:Asserted without figures
    The Comparison

    Which “high-frequency rail”?

    The Alto Files has traced both the $24.5 billion and the $4.9 billion to a September 2024 slide deck shown to deputy ministers and released under Access to Information, where the slower option was priced at $58.9 billion on a new route. Its article sets out how the two figures are built; this brief does not repeat that work. The Alto Files

    The comparator is a different railway

    A 200 km/h option costing $45–75 billion is a new dedicated line. In September 2026 ALTO told Radio-Canada that high-speed rail costs only about 20–30% more than its high-frequency alternative, which is consistent with that range. The existing-corridor package costs $11–30 billion, uses a 177 km/h ceiling, and keeps all 22 intermediate stations. No published ALTO document costs or appraises an option of that kind.

    “Five times” is true on one row only

    ALTO’s Table 2 gives annual GDP effects of 0.2% and 1.1%, which is the “five times”. The same table gives direct benefits to travellers of $33.6 billion and $49.5 billion, or 1.47 times. The Alto Files notes the C.D. Howe Institute reached a similar 1.4 to 1.6 times in 2025.

    Per dollar, ALTO’s two options are close

    Dividing direct benefits by the midpoint of each capital range gives about 0.66 for high-speed rail and 0.56 for the slower option. On the Parliamentary Budget Officer’s $75–113 billion range, the high-speed figure falls to about 0.44–0.66. That range covers construction of the baseline route only, excludes a Kingston routing, and assumes European-level cost efficiency; the PBO puts the chance of costs reaching $243 billion or more at about 1 in 40. These are Initiative calculations from ALTO’s and the PBO’s published numbers. ALTO has said it will not publish a benefit-cost ratio at this stage.

    The $24.5 billion has its own limits

    It is 1.1% of Canada’s 2019 GDP from a static model; the commissioned study’s own range runs from $14.8 to $41.0 billion; about 86% of it rests on one productivity assumption; and the model leaves out construction and operating costs. These are set out in the Initiative’s earlier brief Two Point Two Trillion.

    The Freight Objection

    A rule, not a property of the track

    ALTO is right that freight goes first on the corridor today. That describes how the line is run. ALTO’s own commissioned freight study, High-Speed Rail and Freight Capacity (CPCS with HDR, June 2026), supplies the figures that bear on whether it must stay that way.

    8–13
    CN freight trains a day on Toronto–Montréal, a mix close to 50-50 with passenger trains
    CPCS, p. 8
    3–5
    CN freight trains a day on Montréal–Québec City
    CPCS, p. 8
    8am–8pm
    when freight volumes are lowest and passenger volumes highest
    CPCS, Table 1, p. 10

    Priority is a default

    The Initiative’s brief Canada’s Rail Exceptionalism found that no G7 country gives freight statutory priority over passenger trains, and that the United States legislates the opposite. Canada has none of the usual passenger protections, so freight goes first by default. The study’s third action is aimed at that gap.

    The timetable shows where the time goes

    On single track, VIA’s schedule carries about half the padding where VIA owns the track (29%) as where CN owns it (60%). Montréal–Ottawa, mostly on VIA’s own track, already runs with 8%. Montréal–Québec City, with the fewest freight trains on CPCS’s count, is where the study finds its largest gain from fixing how the two share the line.

    ALTO’s consultant describes the alternative

    CPCS finds “little ability to expand passenger services on lines shared with freight without adding substantial new capacity” (p. 11), and that accommodating freight growth without degrading passenger service “would imply significant investments in the absence of Alto” (p. 6). That investment in the existing corridor is the option the study proposes. The comparison that would settle the question is its cost against the cost of a new line. ALTO has not published it.

    What a response with numbers would contain

    What the reply does not include

    A same-day reply cannot be expected to carry a full appraisal. It can be measured against what ALTO already holds and has not published, and against what the farm associations have asked for.

    Already in ALTO’s hands

    The inputs behind the $4.9 billion Travel times, ridership and productivity assumptions for the slower option. The economic summary ALTO has published models high-speed rail only.
    A source for the $45–75 billion The “high-frequency rail” cost in Canada’s Moment carries no footnote.
    The September 2024 business case Released under Access to Information (A-2026-00195) with most of its pages withheld.
    A figure for the freight harm the release describes The release asserts harm to exporters without a number; ALTO’s freight study does not estimate one.

    Requires an independent process

    An appraisal of the existing-corridor option On the same basis as high-speed rail: cost, ridership, benefits, land, and the added capacity both ALTO’s freight consultant and Vision Transport say is needed. (UPA / OFA / CFA)
    Timing ALTO says a more detailed business case is coming in 2027. Landowners are being asked to make decisions before then. The comparison would need to precede corridor narrowing to inform it.
    Where things stand · November 2026

    Summary ledger

    ALTO’s November 12 reply and the CEO’s interviews, claim by claim, against ALTO’s own published record:

    Not supported
    “Five times the economic benefit”: holds on the GDP row only, and against a $45–75 billion new railway rather than the existing-corridor option. Traveller benefits on the same table: 1.47 times.
    Not published
    A costing of the existing-corridor option: none in any published ALTO document; the release offers an email address.
    Incomplete
    Freight priority: accurate as a description of current operation; ALTO’s own plan keeps passenger trains on the freight line, and its consultant describes the investment alternative.
    Incomplete
    50% faster: holds on ALTO’s estimated times, which are unsimulated, station to station, and serve seven stations rather than twenty-two.
    Incomplete
    Morocco: cited as a high-speed example; operates as a hybrid of new line and upgraded existing line.
    Not addressed
    Five commitments to farmers: the release does not address the difference between a fully grade-separated new line and an option that keeps all 924 existing crossings.
    Inconsistent
    “A TGF doesn’t exist” (CEO, radio): ALTO’s own release the same day puts a $4.9 billion figure on high-frequency rail, and ALTO began as VIA HFR–VIA TGF.
    No figures
    Line closures and “thousands and thousands of properties” (CEO, Canadian Press): no closure period, property count or cost given; the new line’s first segment alone involves just under 2,000 properties.
    Acknowledged
    Farm detours (CEO, radio): no crossing for every farm; detours possible, even probable; compensation method for decades of lost production not published.
    New
    Offer to talk without a confidentiality agreement (CEO, radio): a constructive step if taken up.
    Not answered
    The farm associations’ request for the analyses behind the choice of high-speed rail and an independent comparison.

    Until ALTO publishes otherwise, its comparison is between high-speed rail and a $45–75 billion new railway. The option on the table on November 12 is an $11–30 billion modernisation of a railway that already exists. That is the option nobody has priced.

    Status of the figures

    Published figures on this page are quoted from the named sources and can be checked there. All other figures are Initiative calculations from those inputs, and the inputs are named where each calculation appears. Reconstructions are estimates, not measurements. Where ALTO has not published something, we say so rather than infer its contents, and we make no claim about why any figure was or was not published.

    Download Full Brief
    The Option Nobody Priced (PDF, 10 pages)
    ALTO’s November 12 reply set against Canada’s Moment, ALTO’s freight study and the Vision Transport report
    Download PDF
    Sources

    Primary documents and statements

    1.
    ALTO, “Alto réaffirme l’importance du train à grande vitesse pour le Canada et ses engagements envers le milieu agricole,” Canada Newswire, November 12, 2026. newswire.ca
    2.
    Vision Transport (V. Duguay, with P. DuSablon), Corridor Québec-Toronto : ce que la voie existante permet, November 2026, with presentation and data visualiser. tgf.corda.consulting
    3.
    ALTO, Canada’s Moment: The Economic Opportunity of High-Speed Rail, August 2026, Table 2 and p. 62.
    4.
    CPCS with HDR for ALTO, High-Speed Rail and Freight Capacity: Potential Freight Benefits of Alto, June 2026, pp. 5, 6, 8, 10, 11.
    5.
    The Alto Files, “Five Times What?: Alto’s UPA response,” November 12, 2026, citing ATI release A-2026-00195 and C.D. Howe Institute Commentary 676. thealtofiles.substack.com
    6.
    Ontario Federation of Agriculture, “Farm groups meet to discuss the Alto high-speed rail project,” June 17, 2026. ofa.on.ca
    7.
    P. Saint-Arnaud, “Le PDG d’Alto affirme que le projet de TGF présenté par l’UPA ne tient pas la route,” The Canadian Press, in L’actualité, November 12, 2026. lactualite.com
    8.
    Stone Mills Against Alto, Facebook post, November 12, 2026, with an app-assisted English translation of Martin Imbleau’s interview on La commission (French). CBC News, “Montreal–Ottawa high-speed rail line could cross 1,700 properties, Alto predicts,” May 5, 2026. CBC News
    9.
    Radio-Canada, “TGV d’Alto : « On fait face à des vendeurs de chars », lance l’UPA,” September 2026. ici.radio-canada.ca
    10.
    International Railway Journal, “ONCF completes study into first phase of new Morocco high-speed line.” railjournal.com
    11.
    Office of the Parliamentary Budget Officer, Canada’s Eastern Corridor High-Speed Rail: A Cost Analysis using Global Data, RP-2627-009-C, October 1, 2026.
    12.
    Initiative briefs: Two Point Two Trillion (July 2026); Estimated, Not Simulated (June 2026); Canada’s Rail Exceptionalism (2026); Counting the Crossings (August 2026).
  • Alto CO2 rounding error

    ALTO: A CO2 Rounding Error

    What a high-speed railway contributes to transport decarbonisation, measured against the vehicles on the roads beside it.

    ⚠ The Comparison ALTO’s Business Case Does Not Make

    Over the fifty operating years from ALTO’s first phase opening in 2040 to 2089, at the Initiative’s central ridership forecast and on a consistent life-cycle accounting boundary, ALTO is a net carbon removal of 2.5 Mt CO2e. Electrifying the car and light-truck fleet of Ontario and Quebec over the same period removes 1,097 Mt. Electrifying the heavy trucks removes a further 154 to 668 Mt, depending how fast long-haul freight converts.

    ALTO is between 0.14 and 0.20 per cent of that total.

    Critical Finding

    ALTO is not a material decarbonisation instrument. Road electrification in the two provinces the corridor runs through averages about 28 Mt a year across the period. ALTO’s entire fifty-year net carbon removal is equivalent to roughly one month of it.

    The result is not an artefact of a pessimistic ridership assumption or a hostile accounting convention. It is computed on the most favourable boundary available to the railway: every mode carries its fuel supply chain and its manufacturing, so the electrification figures are already net of battery production and ALTO’s figure is already net of its 14.69 Mt of construction carbon. Measured the narrower way — tailpipe only, as ALTO’s own published material does — ALTO’s position is worse, not better.

    At ALTO’s upper ridership case, a forecast above every independent estimate for the corridor, its share reaches 1.3 to 1.8 per cent. At its lower case it is not a saving at all: the railway emits more over fifty years than it displaces. And ALTO does not repay its own construction carbon until 2083 — six years before the fifty-year operating period closes.

    One contextual finding frames everything below. The federal Electric Vehicle Availability Standard was paused in September 2025 and its repeal posted in the Canada Gazette in August 2026, with nothing in force to replace it. Restoring that mandate’s original trajectory would save a further 165 Mt over the same fifty years in these two provinces alone — roughly sixty-seven times ALTO’s entire net carbon removal. One regulatory decision about car sales outweighs the railway by nearly two orders of magnitude.

    Download
    ALTO: A CO2 Rounding Error — Full Note (PDF)
    Six pages, three tables, four figures — the full method, the fifty-year carbon account, and the four qualifications that belong with the comparison
    Download PDF
    The Finding

    What ALTO saves, and what else is happening

    ALTO is advanced, in part, as a climate measure. This note asks a question: how much carbon does it actually save, set against the other things happening to road transport in the same provinces over the same fifty years?

    2.5 Mt
    ALTO’s net carbon removal over fifty years, central ridership
    net of 14.69 Mt construction carbon
    1,097 Mt
    removed by car and light-truck electrification, Ontario + Quebec
    post-repeal trajectory, same period
    0.17%
    ALTO’s share of combined road electrification, central cases
    range 0.14% to 0.20%

    The three measures are drawn to scale below. ALTO is the narrow band at the right-hand edge; at this scale it is close to the width of the line that marks it.

    Car and light-truck electrification
    1,097 Mt · 77%
    Heavy-truck electrification
    324 Mt · 23%
    ALTO
    2.5 Mt · 0.17%
    Fifty-year totals, 2040–2089, Ontario and Quebec, life-cycle comparison boundary. Heavy trucks shown at the central conversion case (50 per cent of long-haul by 2080).
    Measure50-year savingALTO central as a share
    Car and light-truck electrification, Ontario + Quebec1,097 Mt—
    Heavy-truck electrification — slow25% of long-haul converted by 2080154 Mt—
    Heavy-truck electrification — central50% by 2080324 Mt—
    Heavy-truck electrification — fast90% by 2080, Pembina-aligned668 Mt—
    Combined road electrification — slow truck case1,251 Mt0.20 %
    Combined road electrification — central truck case1,422 Mt0.17 %
    Combined road electrification — fast truck case1,765 Mt0.14 %
    ALTO — lower ridership6.1M passengers a year by 2080−8.3 Mta net emitter
    ALTO — central ridership12.5M by 2080+2.5 Mt—
    ALTO — upper ridership25.7M by 2080, above every independent forecast+22.6 Mt—

    Table 1. Fifty-year carbon saving, 2040–2089, Ontario and Quebec. All figures on a life-cycle comparison boundary: every mode carries its fuel supply chain and its manufacturing, so the electrification figures are already net of battery production and ALTO’s figure is already net of its construction carbon. A negative figure means the measure emits more than it saves.

    The Railway’s Account

    What ALTO saves, and what it costs to build

    ALTO’s saving is the difference between what its passengers would otherwise have emitted and what the railway emits instead, less the carbon spent building it.

    The project opens in three phases — Montréal–Ottawa around 2040, Ottawa–Toronto around 2045, Montréal–Québec City around 2050 — and incurs construction carbon at each. The central estimate for the full 1,000 km corridor is 14.69 Mt CO2e, with a range of 6.87 to 29.60 Mt. Operations over fifty years add a further 2.9 Mt, and permanently severed rural roads a further 0.19 Mt.

    Against that, the displaced trips. On the Initiative’s central ridership trajectory the corridor carries 0.4 million passengers in 2040, 9.2 million by 2055 and 12.5 million by 2080, at a demand-weighted average trip of 430 km. Crediting those trips at the life-cycle intensity of the modes they replace — cars, short-haul aircraft, and the existing VIA Rail service — gives 20.2 Mt of displaced emission over the fifty years.

    ComponentMt CO2e
    Construction, one-time, central estimate+14.69
    Traction, 50 years+0.52
    Fixed operational — stations, maintenance, winter operations+2.29
    Road severance, 50 years+0.19
    Passenger modal shift, 50 years−20.15
    Net fifty-year balance−2.46

    Table 2. ALTO’s fifty-year carbon account, central ridership, IESO 2025 grid outlook, life-cycle comparison boundary. Positive is emission, negative is saving.

    The debt is front-loaded and the repayment is back-loaded

    The concrete is poured in the 2030s and 2040s; the passengers arrive in the 2060s and 2070s. ALTO does not repay its own construction carbon until 2083 — six years before the fifty-year operating period closes, and more than three decades after the date by which Canada’s climate targets fall due.

    The credit is shrinking as it is earned

    ALTO’s saving depends on the carbon intensity of the cars it displaces, which is falling as the fleet electrifies. The saving from moving one passenger out of a car falls from about 57 to about 22 grams per passenger-kilometre between 2050 and 2080 on the operational boundary. The displaced car is getting cleaner whether or not the railway is built.

    The accounting boundary decides the number — and this note uses the generous one

    The narrower tailpipe boundary counts only what comes out of the exhaust while travelling: no refinery, no factory, no battery. Measured that way the displaced cars look cleaner than they are, ALTO’s credit shrinks, and its payback moves from 2083 to 2110. Neither boundary is wrong; mixing them is. Every figure in this note uses the life-cycle boundary, which is the one that favours the railway.

    The Comparison

    What road electrification saves

    The comparison is built from the same inventory the federal government uses, and the same accounting boundary applied to ALTO.

    Natural Resources Canada’s Comprehensive Energy Use Database reports GHG emissions by transportation mode and province. For cars and passenger light trucks the two provinces together emit 39.0 Mt a year as inventoried — Ontario 24.0 Mt in 2022, Quebec 15.0 Mt in 2023. Heavy freight trucks add 18.2 Mt — Ontario 11.8, Quebec 6.4. Those are combustion figures; on the life-cycle boundary they become 63.6 and 22.9 Mt a year.

    Electrifying a car removes 76 per cent of its life-cycle emission on Ontario’s grid: 176 g per passenger-kilometre for an internal-combustion vehicle against 42 g for an electric one, the latter almost entirely battery manufacture rather than electricity. That figure is corroborated independently by TD Economics, which puts the Ontario saving at “around 80 per cent”. Electrifying a heavy truck removes 94 per cent — a battery-electric Class 8 at roughly 63 g per kilometre against diesel’s 1,134 g — because a 600 kWh battery is a far larger manufacturing debt than a car’s, but amortises over a 1.2 million kilometre working life.

    InputValueBasis
    Cars and light trucks, ON + QC39.0 Mt/yrNRCan Table 8, Ontario 2022 and Quebec 2023
    Heavy freight trucks, ON + QC18.2 Mt/yrNRCan Table 8
    Life-cycle multiplier, road passenger1.63Chester and Horvath (2009)
    Life-cycle multiplier, road freight1.26Chester and Horvath (2009)
    Emission removed, car to electric76 %176 → 42 g/pkm, IESO grid
    Emission removed, Class 8 to electric94 %1,134 → 63 g/km, 1.2M km life
    EV fleet share, cars, 2040 → 208015 % → 70 %post-repeal trajectory
    Electrification counterfactual2 % EV fleet, heldtoday’s fleet, frozen

    Table 3. Inputs to the electrification comparison. Road emissions from NRCan Table 8; life-cycle multipliers from Chester and Horvath (2009); grid intensity from the IESO 2025 Annual Planning Outlook. The fleet is held at today’s emission level across the period, on the assumption that growth in vehicle-kilometres and improvement in conventional efficiency broadly offset.

    ⚠ The trajectory used here is the one policy has already given up on

    The car trajectory is the post-repeal one. The federal Electric Vehicle Availability Standard, which required all new light-duty sales to be zero-emission by 2035, was paused in September 2025 and its repeal posted in the Canada Gazette in August 2026 with nothing in force to replace it. This note therefore models a slower fleet conversion than federal policy intended — which makes the electrification figures conservative, not generous.

    That gap is itself instructive. Restoring the mandate’s original trajectory would save a further 165 Mt over the same fifty years in these two provinces alone. One regulatory decision about car sales is worth roughly sixty-seven times ALTO’s entire fifty-year net carbon removal.

    What This Does and Does Not Show

    Four qualifications

    Four qualifications belong with the comparison, and the first is the one a reviewer will raise.

    These are not alternatives, and the figures do not compete

    Building a railway does not prevent electrifying a car fleet, and nothing here says the money should move from one to the other. The two savings add. The comparison establishes proportion, not a choice: it says what weight the carbon argument can bear in a case for ALTO, not whether ALTO should be built.

    The figures do not double-count

    ALTO’s credit is calculated on the electrification trajectory — that is precisely why it erodes over the period. The displaced car is getting cleaner whether or not the railway is built, and the railway’s credit shrinks accordingly.

    The electrification counterfactual is artificial

    Holding the fleet at a 2 per cent electric share for fifty years is not a forecast of anything; it is a device for measuring what conversion delivers. The realistic question is not whether electrification happens but how fast, which is why the car trajectory is taken from post-repeal policy rather than from ambition.

    The scope is deliberately narrow

    Ontario and Quebec road transport only, light-duty and heavy freight. It excludes medium trucks, marine, aviation and rail, and it excludes the rest of Canada. A wider scope would make ALTO’s share smaller, not larger.

    What remains after all four qualifications is a question of proportion that the project’s climate framing does not survive. A railway costing well over $100 billion on the Initiative’s own reference-class estimate, which does not repay its own construction carbon until 2083, removes in fifty years what the vehicle fleet beside it removes in about a month. If ALTO is to be justified, it will have to be justified on capacity, on journey time, or on regional development. It cannot be justified on carbon.

    Where things stand · November 2026

    Summary ledger

    Fifty years, 2040–2089, Ontario and Quebec, life-cycle comparison boundary throughout:

    1,097 Mt
    Car and light-truck electrification — on the post-repeal trajectory, against a frozen 2 per cent electric fleet. The largest single transport decarbonisation measure available in these provinces.
    154–668 Mt
    Heavy-truck electrification — range set by how fast long-haul freight converts. Trucks electrify better than cars per vehicle: 94 per cent of the life-cycle emission against 76.
    165 Mt
    The repealed EV mandate — what restoring the original federal trajectory would add, in these two provinces alone. Roughly sixty-seven times ALTO’s net removal.
    +22.6 Mt
    ALTO at upper ridership — 25.7 million passengers a year by 2080, above every independent forecast for the corridor, including those of McGill’s TRAM group, the Munk School, the C.D. Howe Institute and the federal government’s own 2021 business case.
    +2.5 Mt
    ALTO at central ridership — 12.5 million a year by 2080. Between 0.14 and 0.20 per cent of combined road electrification. Does not repay its construction carbon until 2083.
    −8.3 Mt
    ALTO at lower ridership — 6.1 million a year by 2080. Not a saving at all: the railway emits more over fifty years than it displaces, and never repays its construction debt.
    2110
    ALTO’s payback at the tailpipe boundary — the narrower accounting convention, which this note does not use. On the boundary favourable to the railway, payback is 2083.
    Download Full Note
    ALTO: A CO2 Rounding Error (PDF, 6 pages)
    Complete method, the fifty-year carbon account, annual and cumulative time series at both accounting boundaries, and full sources
    Download PDF
    The research behind the brief

    The brief above is a summary of a five-document research pack. Every figure it quotes is derived in one of these, and each is published in full so the arithmetic can be checked rather than taken on trust.

    Sources

    Primary documents and data

    1.
    Alto HSR Citizen Research Initiative, ALTO Lifecycle CO2 — Construction, Operational and Severance Input Notes, and the Fifty-Year Lifecycle CO2 Output Note, November 2026 update. citizenresearch.ca
    2.
    Alto HSR Citizen Research Initiative, Modal-Shift Note 3: Ridership Envelope and Phasing — the lower, central and upper trajectories used here. citizenresearch.ca
    3.
    Natural Resources Canada, Office of Energy Efficiency, Comprehensive Energy Use Database, Transportation Sector Table 8: GHG Emissions by Transportation Mode — Ontario (2022) and Quebec (2023). oee.nrcan.gc.ca
    4.
    M. Chester and A. Horvath, “Environmental assessment of passenger transportation should include infrastructure and supply chains,” Environmental Research Letters 4 (2009) — the life-cycle multipliers over tailpipe-only accounting. transportationlca.org
    5.
    TD Economics, Lifecycle Emissions: Electric vs Gasoline Vehicles in Canada — Ontario life-cycle saving of “around 80 per cent”; 15,000 km a year over an 18-year vehicle life. economics.td.com
    6.
    Pembina Institute, Zero by 2040: Canada’s Pathway to Net-Zero for Medium- and Heavy-Duty Trucks and Buses — the truck conversion trajectories; long-haul Class 8 identified as the laggard segment. pembina.org
    7.
    Independent Electricity System Operator, Annual Planning Outlook 2025 — Ontario grid emissions trajectory to 2050. ieso.ca
    8.
    Environment and Climate Change Canada, Electric Vehicle Availability Standard — paused September 2025; repeal posted in the Canada Gazette, August 2026. canada.ca
  • One line then the next

    One Line, Then the Next

    What Spain’s high-speed rail experience does, and does not, tell us about ALTO.

    The Commentary

    On October 18, 2026, Fareed Zakaria closed his CNN programme with a segment presenting Spain’s high-speed rail network as evidence that a democracy can still build large infrastructure. He credits Spain’s result to six conditions: building one line first, public finance, low construction cost, routing through less populated land, cross-party support and, since 2021, competition between train operators. He also notes two caveats: low use of parts of the network, and the cost of keeping it safe. CNN transcript

    Spain is the example most often offered for what a Toronto–Québec City line could become. This brief sets each of those conditions beside what has been published about ALTO.

    Key Finding

    On the sources set out here, ALTO shares few of the conditions the commentary identifies. Spain opened a single 471 km line in 1992 and did not open its second until 2003. ALTO’s published plan is a 1,000 km network, with property acquisition on its first segment, Ottawa–Montréal, reported to begin in late 2026 or early 2027.

    Spain’s average construction cost has been reported at €17.7 million per kilometre. ALTO’s $60–90 billion working assumption, divided by 1,000 km and converted at the October 1, 2026 rate, comes to about €38–56 million per kilometre, an Initiative calculation set out below with its limits. Spain financed its network publicly, with a substantial share from the European Union; ALTO is structured as a public-private partnership with no comparable outside funder.

    The Spanish case also carries findings that bear directly on ALTO: Spain’s fiscal authority and the European Court of Auditors have both found that much of the network carries few passengers relative to its cost, and the January 2026 derailment at Adamuz, on the original 1992 line, has made track maintenance a national question. Research also finds the network’s gains concentrated in the largest cities and at stations, with none of the studies reviewed finding that it reversed rural decline between them. These are findings about a network that was built cheaply. The comparison implies that a network costing two to three times as much per kilometre would face the same questions with a narrower margin.

    Download
    One Line, Then the Next — Full Brief (PDF)
    Comparative brief with cost tables, the Spanish build sequence, and 32 numbered sources
    Download PDF
    The Numbers

    Three figures that frame the comparison

    11 years
    between Spain’s first high-speed line (1992) and its second (2003)
    ADIF / Renfe opening dates
    2.1–3.2×
    ALTO’s working-assumption cost per km against Spain’s reported average
    Initiative calculation
    46
    deaths reported at Adamuz, January 18, 2026, on Spain’s first line
    Final investigation report pending

    The commentary is a summary rather than a study, and its figures are round ones. Each is checked here against the underlying sources. Where the sources give a different number, the source figure is used: later reporting puts the Adamuz toll at 46, against the segment’s “more than 40,” and ADIF, Spain’s infrastructure manager, gives the network length as 3,973 km as of March 2026, consistent with the segment’s “nearly 2,500 miles.” ADIF Inspain

    Sequence

    One line at a time

    The Madrid–Seville line was inaugurated on April 14, 1992, timed to Seville’s Expo 92, with stops at Ciudad Real, Puertollano and Córdoba. The next new line, the first section of Madrid–Barcelona, did not open until 2003. The network then grew line by line over two decades. ADIF / Renfe via Wikipedia

    1992
    Madrid–Córdoba–Seville (471 km). The first line, opened for Expo 92.
    2003
    Madrid–Zaragoza–Lleida. First section of Madrid–Barcelona.
    2007–08
    Córdoba–Málaga; Madrid–Valladolid; Madrid–Barcelona completed (621 km).
    2010–13
    Madrid–Valencia, Albacete, Alicante; Barcelona–Figueres, linking to the French network.
    2015–22
    León, Zamora, Granada, Galicia, Burgos, Murcia, Badajoz. Madrid–Galicia took about 20 years of works; Plasencia–Badajoz was built for 200 km/h.

    Spain’s record is incremental, but it is not uniformly fast. Construction of the Basque high-speed line began in 2006 with completion forecast for 2016; completion is now forecast for 2027. Part of the network also consists of lines built or upgraded for 200–250 km/h rather than 300 km/h.

    ALTO’s sequence runs the other way. The federal government chose a high-speed option and selected Cadence in February 2025, and co-development began in March 2025. The plan is for a 1,000 km network. On the first segment, Ottawa–Montréal, ALTO’s chief executive has estimated about 1,700 property acquisitions, about 500 of them farms, with construction in 2029. Ridership has been forecast to 2084. Transport Canada Five Hundred Farms

    What this implies. Spain’s decision to build its second line was taken with years of operating evidence from the first. ALTO’s structure commits to a network before any segment has carried a passenger. On this sequence, the evidence the commentary credits with building support in Spain would not exist for ALTO until after the network’s scope, delivery model and land acquisition are settled.

    Cost

    Cost per kilometre, in the same units

    Four published sources give Spanish construction costs. They use different methods and periods, but each places Spain well below other European builders: an ADIF study gives €6–19 million per km by line; Spain’s fiscal authority, AIReF, €14.7 million (€15.3 million including stations); the engineering firm Ineco €17.7 million, against €45.5 million in other high-speed countries; and the European Court of Auditors €25 million as the average of ten audited lines across six member states. ADIF via Next City AIReF Ineco ECA

    ALTO’s published range is $60–90 billion in 2024 dollars, which its chief executive told a Senate committee is a class 5 internal working assumption rather than a cost estimate. Divided by 1,000 km and converted at 0.62526 euro per Canadian dollar (October 1, 2026), it compares as follows. Senate NFFN

    Initiative calculationLowHigh
    ALTO per route-km (C$)$60M$90M
    In euros at 0.62526€37.5M€56.3M
    Ratio to Spain, Ineco (€17.7M)2.1×3.2×
    Ratio to Spain incl. stations, AIReF (€15.3M)2.5×3.7×
    Ratio to ECA audited average (€25M)1.5×2.3×
    Ratio to other countries, Ineco (€45.5M)0.8×1.2×

    On this arithmetic, ALTO’s range is two to three times Spain’s average and close to the average Ineco reports for other high-speed countries. Spain is the low outlier; ALTO’s range is not an outlier against the international figures. The question the Spanish example raises is whether the conditions that let Spain build at half the international average are present in ALTO’s corridor.

    Limits. The Spanish figures cover construction from 1992 onward and are not stated in a single current price year; in 2024 prices they would be higher and the ratios lower. The published ALTO sources reviewed do not say what the $60–90 billion range includes, and the Spanish sources do not define their scope in the same terms. ALTO’s figure is a class 5 working assumption. The ratios indicate an order of magnitude, not a measured gap.

    Condition by Condition

    What made Spain work, and whether it transfers

    SpainALTO, as published
    Who pays. AIReF reported more than €55.89 billion spent on high-speed lines over 35 years, €14.09 billion (25.2%) of it from EU funds. As reported, Spain received 47.3% of the EU’s high-speed rail co-financing between 2000 and 2017.A public-private partnership that Transport Canada describes as among the largest the Government of Canada has sponsored. ALTO is funded by appropriations during development ($597 million in 2025–26). Canada has no outside funder in the EU’s position, and the terms of construction financing are not set out in the published sources reviewed.
    Transfers to ALTO:No
    Who builds. ADIF, the state infrastructure manager, has built line after line since the early 1990s, carrying its experience from one to the next.A first line, with no domestic high-speed construction programme behind it. The private partner develops and designs the project with ALTO during co-development. Cadence comprises CDPQ Infra, AtkinsRéalis, SYSTRA, Keolis, SNCF Voyageurs and Air Canada.
    Transfers to ALTO:No
    Where the line runs. Routing through less populated land lowered cost. Spain’s first line stopped at Ciudad Real and Puertollano, and the commentary describes the network as connecting urban and rural Spain.In Eastern Ontario, less populated land means farmland: about 500 farms on the first segment, under a statute that removes the standard attempt-to-purchase step and the public hearing on objections. Seven stations on 1,000 km, four of them in Québec; none between Peterborough and Ottawa.
    Transfers to ALTO:No
    Consensus. The commentary describes high-speed rail as a rare subject of cross-party agreement. The European Court of Auditors found, however, that decisions to build were often political and that cost-benefit analysis was not generally used.Consensus has not formed. OFA and UPA, the Canadian Federation of Agriculture and Beef Farmers of Ontario have each called for the project to be halted or suspended pending assessment. In February 2026, senators asked whether a cost-benefit analysis had been done.
    Transfers to ALTO:Not yet
    Fares and competition. Ouigo entered in 2021 and Iryo in 2022. Spain’s competition authority reports Madrid–Barcelona tickets about €25 cheaper after liberalisation, fares on the main routes about 40% below 2019 in real terms, and 44.5 million passengers in 2025.One consortium develops and operates. The sources reviewed do not describe other operators competing on the new line. Air Canada, which operates air services between the corridor’s cities, is a consortium member.
    Transfers to ALTO:Not in published structure
    Demand. AIReF found Spain’s network the least used of the large networks, with socio-economic returns between zero and minimal in all four corridors it evaluated. Per-kilometre use was about a quarter of France’s.A forecast of 24 million trips a year by 2055 would exceed the Court’s nine-million benchmark for a successful line, and the corridor has about 18 million residents. Spain’s demand record is observed; ALTO’s is a forecast made before a cost estimate exists.
    Comparison:ALTO’s strongest point, unproven
    Upkeep

    Adamuz and the cost of keeping a line safe

    On January 18, 2026, an Iryo train derailed near Adamuz, Córdoba, on the Madrid–Seville line, and collided with an oncoming Renfe train; 46 deaths have been reported. The railway accident investigation commission, CIAF, stated in an interim note that its working hypothesis was a rail fracture at a weld that occurred before the Iryo train passed. Spain’s transport minister said the section had been renovated in May 2025. The train drivers’ union had written to ADIF in August 2025 about wear on that section, and the CIAF has reported inconsistencies in the documentation on the welds. As of the most recent reporting found, the final report has not been published. This brief makes no finding on the cause. CIAF Reuters

    The line involved was Spain’s first, 34 years old at the time. Maintenance is a lifecycle cost that grows as a network ages, and it is the cost least visible when a project is announced. The Initiative’s earlier operating-cost work estimates ALTO’s recurring lifecycle cost at about $1.8 billion a year at ALTO’s 3.5% discount rate. Cost of Running the Train

    Who Gains

    Who gains, and who does not

    Rural depopulation in Spain predates the high-speed network by most of a century. The share of Spaniards living in municipalities under 2,000 inhabitants fell from 27.5% in 1900 to 5.7% in 2021, though such places still make up 72.2% of all municipalities. Of 5,678 small municipalities studied, 56.9% lost population in both post-crisis periods examined, about 404,000 people combined, and the authors judge that around 3,300 face a bleak outlook. Gil-Alonso et al. 2023

    On 2018 INE data, 53% of Spain’s area holds about 5% of its population at under 12.5 inhabitants per km². elDiario.es The evidence reviewed does not show that high-speed rail caused this decline. The question it can answer is narrower: whether the network changed the pattern, and for whom.

    Gains concentrate at the ends

    On Madrid–Seville, population growth and land development concentrated “mostly towards the two largest cities.” Ciudad Real, within commuting range of Madrid, gained; Puertollano, one stop further, seldom did. Shen et al. 2015 Shen et al. 2016

    Stations matter

    Provinces with stops on Madrid–Barcelona saw on average about 2.4% higher output and 3.3% more firms. Across Spain, service has been associated with population growth overall, but not in every case: a required condition for development, not a guarantee of it. Carbo et al. 2019 Miralles i Garcia 2019

    The places in between

    The coverage gap is greatest for smaller, peripheral municipalities and those between lines, and strengthening links among the largest places could further isolate the smallest. Activity concentrates in the most developed nodes, and areas without a station can see service degradation. None of the studies reviewed finds that high-speed rail reversed rural decline between stations. Naranjo Gómez et al. 2020 Albalate & Bel 2026

    Local evidence from those places is mostly advocacy and press reporting. A users’ association reports Linares-Baeza station fell from 56 passenger trains a day before 1992 to 14. Soria, reported to be the only province the high-speed line crosses without a stop, has had no operating rail service since April 2025. In May 2025, farm unions in Sanabria, Zamora, protested a proposal to remove high-speed stops to shorten journeys to Vigo, citing depopulation and access to medical care. Each intermediate stop slows the trains for everyone travelling end to end, so the stops that provide access are the first to come under pressure. Moncloa El Debate Agronews

    What this implies for ALTO. ALTO’s published plan has seven stations on 1,000 km, none between Peterborough and Ottawa. On the Spanish evidence, gains would concentrate in the end cities and at those stations, while the rural communities between them carry the land acquisition without a station of their own. Transport Canada’s 2025 briefing records funding for the planning and eventual transfer of VIA Rail’s Québec City–Windsor corridor services to the private partner; the published sources reviewed do not say what service would continue at VIA’s intermediate stations. On the Spanish record, that is the question that decides whether the places between the stations gain or lose. Transport Canada

    Implications for ALTO

    What the Spanish case supports, and what it does not

    What it supports

    Democracies can build A democracy can build an extensive high-speed network at a cost per kilometre well below the international average. On the sources here, the commentary’s central point holds.
    Stages produce evidence Building in stages lets each later decision use evidence from the lines already running.
    Competition lowers fares Independent operators competing on publicly owned track can lower fares and raise use.

    What it does not support

    That ALTO would cost what Spain cost The conditions behind Spain’s costs are largely absent from ALTO’s corridor and delivery model.
    That high-speed lines fill wherever built Spain’s own fiscal authority and the EU’s auditors found otherwise on much of the network.
    That construction is the whole story The Adamuz investigation concerns the upkeep of Spain’s oldest line.
    That benefits spread evenly Research finds gains concentrated in the largest cities and at stations; none finds it reversed rural decline between them.

    On the arithmetic and sources set out here, the Spanish case is better read as a description of a method than as evidence for a particular project. ALTO’s published plan differs from that method in sequence, cost, finance, routing, station spacing and market structure. The comparison implies that whether Canada can build depends less on whether high-speed rail is built than on how it is built.

    Status of the Figures

    Published figures on this page are quoted from the named sources and can be checked there. All other figures, including every per-kilometre figure and ratio for ALTO, are Initiative calculations from those inputs: ALTO’s published range, a 1,000 km route length and the October 1, 2026 exchange rate. Reconstructions are estimates rather than measurements. Where ALTO has not published something, such as a breakdown of its cost range or the terms of construction financing, the text says so rather than inferring it. No claim is made about why any particular figure was or was not published.

    Download Full Brief
    One Line, Then the Next (PDF, 12 pages)
    Full comparison with the Spanish build sequence, four cost sources, the per-kilometre calculation and its limits, and 32 numbered sources
    Download PDF
    Sources

    Primary documents and reporting

    1.
    CNN, Fareed Zakaria GPS, transcript, aired October 18, 2026. transcripts.cnn.com
    2.
    ADIF, “Red de alta velocidad” (network length 3,973 km, March 2026). adifaltavelocidad.es
    3.
    Wikipedia, “High-speed rail in Spain” (opening dates, speeds, construction delays; drawing on ADIF and Renfe), accessed October 19, 2026. wikipedia.org
    4.
    Associated Press, report on the Adamuz collision, January 19, 2026, citing EU figures of more than 3,100 km of Spanish line above 250 km/h. gpb.org
    5.
    Next City, “New Starts: Spain’s Dirt-Cheap High-Speed Rail,” reporting an ADIF study of cost per kilometre by line. nextcity.org
    6.
    Ineco, Efficiency of the Spanish Sector in High-Speed Rail Development, as reported by Global Railway Review and Forbes España. globalrailwayreview.com
    7.
    AIReF, spending review of transport infrastructure (2020), as reported by International Railway Journal. railjournal.com
    8.
    European Court of Auditors, Special Report 19/2018, A European high-speed rail network: not a reality but an ineffective patchwork. op.europa.eu
    9.
    Reporting of ECA Special Report 19/2018 figures for Spain: Ara, June 27, 2018; Catalan News, June 26, 2018. ara.cat · catalannews.com
    10.
    CNMC data as reported by Railway Pro (2026) and International Railway Journal (2023); Frontier Economics on liberalisation; Hosteltur on the transport minister’s comments. railwaypro.com · frontier-economics.com · hosteltur.com
    11.
    CIAF, note on the investigation of the Adamuz accident, January 2026; Railway Gazette International, January 27, 2026. transportes.gob.es · railwaygazette.com
    12.
    Adamuz reporting: The Citizen (Reuters), January 19, 2026; Ara, on weld documentation (March 2026); Inspain (September 2026). thecitizen.co.tz · ara.cat · inspain.news
    13.
    Transport Canada, Committee of the Whole briefing binder, “VIA HFR – VIA TGF Inc. (Alto),” June 2025. tc.canada.ca
    14.
    Standing Senate Committee on National Finance, evidence, February 24, 2026. sencanada.ca
    15.
    Library of Parliament, HillStudy, VIA Rail: Its Past, Its Present and the High-Speed Rail Project, executive summary, May 4, 2026. hillnotes.ca
    16.
    OpenCouncil, “Alto High-Speed Rail” project summary, January 2026. opencouncil.ca
    17.
    Millstone News, “Alto: Coming soon to a neighbourhood near you?”, July 21, 2026. millstonenews.com
    18.
    ALTO HSR Citizen Research Initiative, Five Hundred Farms (May 2026), and the sources cited there. citizenresearch.ca
    19.
    Exchange-rates.org, CAD/EUR rate for October 1, 2026 (1 CAD = 0.62526 EUR). exchange-rates.org
    20.
    ALTO HSR Citizen Research Initiative, earlier briefs: North American vs. European Regulation of High-Speed Rail; Three Claims, One Fare; Cost of Running the Train (all August 2026). citizenresearch.ca
    21.
    Gil-Alonso, Bayona-i-Carrasco & Pujadas-Rúbies, “Is Spanish depopulation irreversible?”, Vienna Yearbook of Population Research 21(1), 2023. austriaca.at
    22.
    elDiario.es, “Radiografía de la España vacía,” March 29, 2019 (INE data for 2018). eldiario.es
    23.
    Shen, Zhao, de Abreu e Silva & Martínez, Madrid–Seville HSR and population growth, TRB 2016. mit.edu
    24.
    Shen, de Abreu e Silva, Zhao & Martínez, 15 years’ impacts of Madrid–Seville HSR, TRB 2015. mit.edu
    25.
    Carbo, Graham, Anupriya, Casas & Melo, causal economic impacts of the Madrid–Barcelona HSR corridor, 2019. figshare.com
    26.
    Miralles i Garcia, “High-speed rail services in Spain and their relationship to population growth,” WIT Transactions on the Built Environment 182, 2019. witpress.com
    27.
    Naranjo Gómez et al., “Assessment of high-speed rail service coverage in municipalities of peninsular Spain,” Infrastructures 5(2), 2020. mdpi.com
    28.
    Albalate & Bel, When Speed Outruns Demand, ADBI Policy Brief 2026-6, March 2026. adb.org
    29.
    Moncloa.com, “El AVE y la España vaciada de trenes convencionales,” July 2019 (union and users’ association figures). moncloa.com
    30.
    El Debate, on Soria’s rail isolation lasting until 2027, July 20, 2026. eldebate.com
    31.
    Agronews Castilla y León, Sanabria protest against removal of high-speed stops, May 21, 2025. agronewscastillayleon.com
    32.
    Transport Canada, Minister’s briefing binder, “High-Speed Rail,” June 2025. tc.canada.ca
  • 3 claims 1 fare

    Three Claims, One Fare

    ALTO makes three promises about the high-speed railway. All three depend on one number it has never published — the price of a ticket.

    The argument in plain terms

    ALTO promises three things at once: that 24 million people a year will ride the new railway; that they will save 9.3 billion hours of travel time, worth $49.5 billion; and that ticket sales will cover the cost of running and maintaining the line. Each promise sits in a different part of the report, backed by different evidence.

    All three depend on one number the report never gives: the price of a ticket. Cheap tickets fill trains, which is what the first two promises need. Expensive tickets bring in the revenue the third promise needs. A fare cannot be cheap and expensive at the same time, so the three promises pull against one another.

    Work out the single fare at which all three could hold, and it comes to about 19 cents per kilometre travelled — roughly $83 for a typical 428-kilometre journey. At that price the railway breaks even only if 24 million people ride it, and 24 million people ride it only if the corridor is generating about 74 million intercity trips a year, by all modes. On ALTO’s own population figures, the corridor will generate about 34 million.

    So making all three promises at once means making a fourth one that is never stated: that by 2055 the corridor would have to be generating more than twice the intercity travel that ALTO’s own population figures produce. Nobody forecasts travel on that scale, and that is exactly the difficulty.

    ⚠ How to read the fares on this page

    Fares here are given per kilometre travelled, because that is how railway revenue is calculated. A passenger-kilometre is simply one traveller going one kilometre, so a fare of $0.15 per kilometre means a passenger pays 15 cents for every kilometre of their journey. Multiply by 428 km — the average journey — for a rough ticket price: $0.15 is about $64, $0.22 about $94, $0.28 about $120, and the $0.193 break-even fare about $83.

    Modal Shift Notes and O&M Notes, referred to throughout, are earlier papers in this series and are available at citizenresearch.ca.

    2.19×
    how much more intercity travel the corridor would have to generate for all three promises to hold: 73.9 million trips a year against 33.7 million forecast
    §6.1
    $0.193
    the only fare at which all three could hold — about $83 a journey. At that price the railway carries about 11 million riders, not 24 million
    §6.1
    63%
    the most of its running costs the railway can recover from fares at any price. Fares pay about 63 cents of every dollar; the rest comes from the public
    §8
    Download
    Three Claims, One Fare — Full Brief (PDF)
    The complete arithmetic, set out step by step, with every figure sourced so that any part of it can be checked or rejected

    Download PDF

    The Three Promises

    Three claims that are only ever made separately

    Where this comes from. ALTO is the company proposing the high-speed railway. In August 2026 it published a report, Canada’s Moment: The Economic Opportunity of High-Speed Rail, making the three claims set out below. This page is a plain-language version of an independent check of those claims against published population and travel data — in effect, a fact-check of ALTO’s report. Every step of the arithmetic is shown so that any part of it can be rejected.

    Three numbers do the persuasive work in ALTO’s report Canada’s Moment. They appear in different chapters, rest on different evidence, and are never set side by side. Put side by side, they turn out to want opposite things from the price of a ticket.

    The Promise What it needs the ticket price to do
    1. Ridership. 24 million passengers a year by 2055, rising after that. Be low. The cheaper the ticket, the more people ride — and for a family of three or more, driving already costs almost nothing extra.
    2. Economic benefit. 9.3 billion hours of travel time saved, worth $49.5 billion. Be low. Every benefit counted in the appraisal — time, car costs, safety, congestion, emissions — depends on how many people actually switch to the train.
    3. Paying its own way. “The railway pays for its own operations and maintenance.” Be high. Most of the cost of running the railway stays the same whether the trains are full or empty, so covering it depends on how much each passenger pays.

    The first two promises pull the fare down. The third pulls it up. That is not a criticism of high-speed rail; every high-speed railway ever built faces the same squeeze. The criticism is that the report presents all three as true at the same time without ever showing the fare that would deliver them.

    Why These Are One Promise

    Everything runs through the ticket price

    Picture a single dial: the price of a ticket. Turning that one dial moves all three of ALTO’s claims at the same time, because all three are calculated from it. Turn the price down and more people ride, which automatically raises the total hours saved, because total hours saved is just hours per person multiplied by the number of people. But turn the price down and each ticket brings in less money, so covering the railway’s costs gets harder. The three claims are not three separate discoveries. They are three readings taken off the same dial — and ALTO’s report never shows you the setting it used.

    The fare is not a detail to be settled later, once the business case is agreed. It is the number the business case turns on. It enters the arithmetic twice, pulling in opposite directions, and everything else follows automatically.

    1 — The fare sets how many people ride

    The fare sets how expensive the train is next to driving or flying, which sets the share of trips that choose rail. Apply that share to the total number of intercity trips in the corridor and you have annual ridership.

    2 — Ridership sets both the benefits and the revenue

    Riders multiplied by the length of the average journey gives total passenger-kilometres. That single quantity drives the hours saved and the ticket revenue. There is no way to improve one without damaging the other.

    3 — So the first two promises are the same promise

    If the hours saved per passenger are held at ALTO’s own figure, the economic benefit is simply the number of riders multiplied by a fixed amount. The $49.5 billion is the 24 million riders, restated in dollars. That leaves two propositions, not three: one about demand, one about covering costs.

    Three numbers agreeing is not three checks passing

    If one team checked ridership, another checked time savings and a third checked whether fares cover costs — each using its own method — and all three agreed, that would mean something. That is not what happens here. All three start from the same unpublished ticket price, so of course they agree. They are three shadows cast by the same object. They will always line up, and their lining up is no evidence that the object is the right shape.

    4 — And two propositions have one joint answer

    Two equations with two unknowns — the fare and the number of riders — will usually have a solution. The claims are not inconsistent with one another. The question is what that solution demands of the corridor.

    The Travel Market

    How much intercity travel there is to win

    The corridor’s total travel market is its population multiplied by the number of intercity trips each resident makes on the routes the railway would serve. Modal Shift Note 3 puts the 2025 corridor population at about 14.9 million across the cities directly served, growing at 1.0 per cent a year, and puts intercity travel at about 1.68 trips per resident per year.

    20.1M
    people living in the corridor in 2055, on the central growth path
    Modal Shift Note 3
    33.7M
    intercity trips a year in 2055, by every mode — car, air, bus and rail combined
    20.1M × 1.68 trips each
    71%
    the share of that entire market ALTO’s 24 million riders would represent
    24.0M ÷ 33.7M

    Seventy-one per cent of all intercity travel — car, air, bus and rail together — is a share no high-speed railway is known to have won. It is worth being precise about this, because the famous European figures look higher and are not the same measure. Roughly 75 per cent of Madrid–Barcelona travellers choose the train over the plane, and more than 80 per cent on Madrid–Seville; those are shares of the rail-and-air market, which excludes the car. Against a car that costs its driver almost nothing extra to fill, no comparable share of the whole market has been recorded. Nor is 71 per cent a forecast that fails at some fares and works at others. As the sections below show, no fare produces it.

    What Each Ticket Price Delivers

    Three realistic fare levels, and what each one buys

    Modal Shift Note 3 sets out three combinations of fare and subsidy spanning the realistic range of policy, and reports the share of the market each one wins. The dollar figures are this note’s translation of those descriptions into a fare per kilometre; Note 3 publishes no dollar figures, so the translation is an inference. Every figure below uses the version most favourable to the project.

    The Fare Level What it delivers
    A — Heavy subsidy. $0.15 per km (about $64 a journey). Fares held at today’s VIA Rail levels, with $2.5–4.5 billion a year of public money covering construction costs. 13.5 million riders a year — 38–42% of the market. $27.8 billion of benefit against the $49.5 billion claimed. Fares cover 54% of running costs.
    All three promises:Not met
    B — Moderate subsidy. $0.22 per km (about $94 a journey). Fares matched to airfares, with $1.5–2.5 billion a year of public money covering construction costs. The arrangement the published business case appears to assume. 10.1 million riders a year — 28–32% of the market. $20.9 billion of benefit. Fares cover 64% of running costs — the best result available at any price.
    All three promises:Not met
    C — Minimal subsidy. $0.28 per km (about $120 a journey). Fares set by a private operator to maximise revenue, above airfare levels, with $0.5–1.5 billion a year of residual public support. Closest to a commercially structured P3; ALTO has published no payment mechanism. 7.3 million riders a year — 20–23% of the market. $15.0 billion of benefit. Fares cover 63% of running costs.
    All three promises:Not met
    ALTO as published. No fare stated anywhere in the report. 24.0 million riders a year — 71% of the market. $49.5 billion of benefit. Fares cover 100% of running costs.
    Fare required to produce this:Never published

    Even on the most generous treatment — the heaviest subsidy, mature ridership rather than the slower build-up of the opening years, and ALTO’s own hours saved per passenger accepted exactly as published — the economic benefit is $27.8 billion, not $49.5 billion. That is a reduction of 44 per cent arising from the ridership side alone.

    Paying the Running Costs

    Why cheap tickets cannot fix the finances

    Think of a gym. It pays rent whether 10 people turn up or 1,000 — that cost is fixed. It also buys more towels and cleaning supplies as more people come — that cost varies with use. A railway works the same way, and the split matters more than it might sound.

    Running a railway costs money in two ways. Some costs stay the same however many people ride — track, structures, signalling, stations, head office, and buying the trains. Others grow with the number of trains you run. On ALTO’s own figures, spread over the life of the assets at its own 3.5 per cent rate, the fixed block is $1,130 million a year, and 61 per cent of the total cost does not move with ridership at all.

    That is why cutting fares to fill the trains does not fix the finances. It helps a little at first — more passengers spread across the same fixed cost — and then makes matters worse, because each extra passenger is paying less. Cost recovery does not simply improve as fares rise. It improves, peaks, and then falls back.

    Chart: economic benefit delivered and share of running costs covered by fares, at each fare. Neither of ALTO's two claims is ever reached.

    Figure 2. Neither promise is ever reached. The economic benefit delivered (navy, left axis) and the share of running costs covered by fares (rust, right axis), at each fare. The two gold lines are ALTO’s two claims. Benefit falls steadily as fares rise; cost recovery rises, peaks well short of covering everything, then falls away as riders drop off. The fare that comes closest to one claim is far from the other. The chart shows cost recovery as a ratio, so its peak of 0.63 is the 63 per cent described here, and the gold line at 1.00 is fares covering costs in full.

    The ceiling is about two-thirds

    The turning point sits at a fare near $0.26 per kilometre, where fares cover about 63 per cent of running costs. The best of the three published levels reaches 64 per cent. At no price in the corridor as forecast do fares cover the cost of running the railway. Fares pay about 63 cents of every dollar; the remaining 37 cents comes from the public, every year, forever.

    And the best fare for the finances is the worst for the benefits

    The fare that comes closest to paying for the railway delivers roughly $16 billion of the claimed $49.5 billion in benefits. The fare that comes closest to one promise is nowhere near the fare that delivers the other.

    Against the cost of building it, nothing reaches a dollar

    Construction of roughly $75 billion, spread across 2027–2037 and discounted at 3.5 per cent, is worth about $57 billion in today’s dollars. Measured against that, every dollar returns 49 cents of benefit at fare level A, 36 cents at level B and 26 cents at level C. ALTO’s own published benefits return 86 cents — and that failure is ALTO’s own arithmetic, not this note’s. None of these figures counts the operating shortfall above, which the public would have to fund on top.

    The Three Promises Joined Up

    There is exactly one answer, and it is about the corridor

    The obvious next step is to check the promises one at a time and report that none of them survives. That is true, and it is set out below. But it is the weaker exercise, because it invites the reply that the whole thing is merely a disagreement with three forecasts.

    A short detour, because the next step depends on it. Suppose you are told two things about a bag of marbles: it holds 18 marbles, and there are twice as many red ones as blue. Neither fact on its own tells you how many are red. Put them together and there is exactly one answer — 12 red and 6 blue. Two facts, each loose on its own, can lock onto a single exact answer once you require both to be true at the same time.

    The same move works on the railway. “24 million riders” is one fact. “Fares alone cover the running costs” is another. Neither tells you the ticket price by itself — plenty of low prices might draw 24 million riders, plenty of high ones might cover costs. Require both at the same price, and as with the marbles there is only one price where that is possible.

    The stronger exercise is to solve the two propositions together and ask what corridor would satisfy them. Covering costs fixes a relationship between the fare and the number of riders; so does the ridership promise. Two equations, two unknowns, one answer.

    The one fare, and the one market, that satisfy all three

    Covering 100 per cent of running costs at exactly 24 million riders requires a fare of $0.1935 per kilometre. At that fare the train wins 32.5 per cent of the market. For 32.5 per cent to equal 24 million riders, the corridor must be generating 73.9 million intercity trips a year. It is forecast to generate 33.7 million. The ratio is 2.19×.

    There is only one such point, and it is worth being clear about why. Above $0.193 the railway covers its costs but carries fewer than 24 million people; below it, it carries more but cannot pay for them. Only at $0.193 do the two meet, and where they meet is fixed by the size of the market. The three promises do not contradict each other. They contradict the corridor.

    That unstated assertion has a value, and it can be put in whichever units a reader finds easiest to judge:

    Expressed as Required by the three promises, against the forecast
    Intercity trips a year, all modes 73.9 million required, against 33.7 million forecast — 2.19×
    People living in the corridor in 2055 44.0 million required, against 20.1 million forecast — more people on the Toronto–Québec City axis alone than live in Canada today
    Intercity trips per resident, per year 3.68 required, against 1.68 — corridor residents travelling more than twice as often as the evidence supports, at a time when remote and hybrid working push the other way
    Annual population growth, 2025–2055 3.7 per cent a year sustained for three decades, against a central forecast of 1.0 per cent and a high forecast of 1.6

    Anyone wishing to defend all three promises therefore has exactly one thing to defend, and it is a claim about demand rather than about engineering or financing. Cheaper construction, faster trains and a different discount rate do not reach it. Only a larger travel market does.

    The Gap That Does Not Close

    No ticket price escapes the problem

    Within the corridor as forecast, is there some fare — between the three levels above, or beyond them — that escapes the problem? There is not, and the reason is structural rather than a matter of forecasting.

    Two things happen at once as the price goes up. The number of riders the railway needs in order to break even falls gently and steadily, like walking down a slope — each rider is worth more, so fewer are needed, but that effect fades out gradually. The number of riders available falls away sharply, because once the train costs about what driving costs, people stop switching to it very quickly. A gentle slope and a cliff do not meet.

    Put more precisely: raising the fare lowers the number of riders needed to break even, because each remaining passenger contributes more. But raising the fare also lowers the number of riders available, and it does so faster. The first effect tails off gradually. The second accelerates, because once the train loses its price advantage over a car that costs almost nothing extra to fill, passengers fall away sharply. The second effect always wins.

    Chart: the market share the railway needs to cover its costs, against the share it can win, at each fare. The two curves never meet.

    Figure 1. The two curves never meet at any fare. The rust curve is the share of the market the railway would need to cover its running costs; the solid navy curve is the share it can actually win. The shaded area between them is the gap. The dashed navy curve is the same demand curve in a corridor generating 2.19 times as much travel — it touches the rust curve at exactly one point, $0.193, and that point sits on the gold line marking the 71 per cent share ALTO’s 24-million forecast implies. The chart labels this share “capture”, and the fare “fare yield, dollars per passenger-kilometre”.
    At this fare Market share needed, against market share achievable
    $0.15 per km — fare level A
    about $64 a journey
    Needs 117.7% of the entire intercity market. Can win 40%. The railway would have to carry more trips than exist in the corridor at all, across every mode, simply to cover its running costs.
    $0.22 per km — fare level B
    about $94 a journey
    Needs 57.3%. Can win 30%.
    $0.28 per km — fare level C
    about $120 a journey
    Needs 39.8%. Can win 21.5%. This is as close as the gap ever comes: 1.85×, at about $0.29.
    $0.40 per km
    about $171 a journey
    Needs 24.7%. Can win 12.1%. The gap has started widening again as the ridership base collapses.

    Read the last figures as the size of the gap: at every fare, the railway needs between roughly twice and three times the market share it can actually win. There is no fare at which it closes.

    What Would Have To Change

    Fixing one promise at a time

    These are the terms a proponent is most likely to reply in. Three of the four turn out not to reach the joint answer at all.

    A larger travel market — reaches all three

    A corridor population of 34.0 million by 2055, or 2.85 trips per resident, brings 24 million riders within reach. Covering the running costs as well takes the 44.0 million of the joint answer. This is the only repair that reaches all three promises.

    Longer journeys — does not move ridership

    An average journey of 793–1,259 km, against the 428 km assumed — meaning essentially every passenger riding Toronto to Québec City end to end, and at fare level A a journey longer than the line itself. It would help cover costs. It puts nobody extra on a train.

    Lower running costs — covers costs only

    Running costs 37–46 per cent below the O&M Note estimates, with the fixed block down from $1,130 million to about $564 million. Again, nothing on the cost side puts passengers on trains.

    A stronger switch to rail — the same claim in different units

    The whole demand curve lifted by a factor of 2.19 at every fare. This is arithmetically identical to a bigger market, and equally a claim about demand.

    This is the asymmetry the brief turns on. Repairs on the cost side rescue the cost-covering promise and leave the ridership promise exactly where it was, because nothing on the cost side puts passengers on trains. Only a larger travel market reaches all three, and both routes to one — more people, or a greater willingness to switch — are the same claim in different units.

    Where Things Stand · August 2026

    Summary ledger

    Taking the promises one at a time, in the corridor as forecast, at every fare examined:

    Not met
    24 million riders a year. The ceiling across the whole fare range is 13.5 million. At the break-even fare of $0.193 it is about 11 million.
    Not met
    $49.5 billion in economic benefits. The ceiling is $27.8 billion, and that figure accepts ALTO’s own hours saved per passenger without challenge.
    Not met
    Fares cover the cost of running and maintaining the railway. The ceiling is 63–64 per cent, at any price, in the corridor as forecast.
    Robust
    The ceiling on cost recovery is the solid half of this finding. It sits inside the range of fares the modelling actually covers, and needs no projection beyond it.
    Softer
    The ceilings on riders and benefits involve projecting beyond the tested range at fares below $0.15, and a proponent is entitled to challenge them. The joint answer at $0.193 does not depend on any such projection.
    Answerable
    A proponent who accepts a 73.9-million-trip corridor is entitled to hold all three promises at once — and should be asked to say so plainly.

    The three promises are not logically inconsistent with one another, and this brief does not claim they are. There is a genuine joint answer. The difficulty is that the answer describes a corridor that does not exist — and that the fourth promise, the one about how much travel the corridor generates, is the only one ALTO has never had to defend, because it has never been stated.

    That distinction is not a technicality. A single claim that says “this project needs more than twice the travel demand anyone forecasts” invites immediate scrutiny. Three separately sourced numbers that merely happen to agree do not. Splitting one unproven assumption across three chapters is what allowed it to travel through public debate unchallenged — and catching that before tens of billions of public dollars are committed is the whole point of a review like this one.

    Download Full Brief
    Three Claims, One Fare (PDF)
    The complete arithmetic with every step shown, for anyone who wants to check or reject any part of it

    Download PDF

    Limits

    What this brief does not claim

    The translation of the three fare levels into dollars is an inference

    Modal Shift Note 3 defines the three levels by how much subsidy they need and how they compare with airfares, not in dollars per kilometre. The $0.15, $0.22 and $0.28 figures are this brief’s reading of what those descriptions imply. Anyone who rejects the reading should supply the fares the business case actually assumes — and the conclusion holds across the whole range of fares, not only at those three points.

    The 428-kilometre average journey is an assumption

    Carried over from revised O&M Note 3. It matters a great deal: revenue and hours saved both rise and fall with it.

    The construction cost figure is not ALTO’s

    The $75 billion is the midpoint of the $60–90 billion range used elsewhere in this series. ALTO publishes no comparable figure. The returns per dollar should be read as indicative, and they measure benefits against construction cost alone.

    Nothing here depends on the 9.3-billion-hour figure being correct

    It is held at ALTO’s own value throughout. If it is correct, the findings stand as stated. If it turns out to be overstated, the benefit column falls further still and every conclusion here becomes firmer, not weaker.

    The model of the train service is coarse

    A single 450-seat train type, uniformly 65 per cent full over a 1,000-kilometre corridor, is a simplification. A real railway would vary train length and frequency by section, which would cut the ridership-related costs somewhat when ridership is low. It would not touch the fixed costs, which is where the problem lies.

    Sources

    Primary documents and companion notes

    1.

    ALTO, Canada’s Moment: The Economic Opportunity of High-Speed Rail, August 2026. The 24-million ridership forecast, the 9.3 billion hours of travel time saved and the $49.5 billion total benefit figure at a 3.5 per cent discount rate.
    2.

    ALTO, Canada’s Moment, August 2026. The claim appears three times: in the chief executive’s foreword, where revenues are expected to cover all operating and maintenance costs and to offset the ongoing public subsidies conventional passenger rail has historically required; in the executive summary, where operating revenues are expected to fully cover operating and maintenance costs, transitioning passenger rail from a publicly subsidised service to a commercially viable operation; and in the financial chapter, where the project is expected to operate on a self-sustaining basis. The same chapter distinguishes day-to-day operating costs from initial capital investment and lifecycle costs, and states that revenues do not cover all costs once those are included — the distinction examined in revised O&M Note 3, which finds the claim true for day-to-day operations alone, marginal once renewals are included, and failing once the trains themselves have to be replaced.
    3.

    Modal Shift Note 3 — corridor population, starting point and growth path; intercity trips per resident. The 1.68 figure is the 2025 baseline; the working range is 1.6–1.8. Using 1.68 is marginally conservative against this brief’s own conclusion.
    4.

    Modal Shift Note 3 — market shares of 38–42, 28–32 and 20–23 per cent for the three fare levels, which Note 3 calls Regimes A, B and C.
    5.

    Revised O&M Note 3 — infrastructure $1,016M, operations $700M and fleet $127M a year, spread over the life of the assets at 3.5 per cent real; the fixed and variable split giving $1,130M fixed and $8.91M for each train per day.
    6.

    Statistics Canada, The Daily, 17 June 2026 — Canada’s total population estimated at 41,417,056 on 1 April 2026, a decrease of 55,025 over the preceding quarter.
    7.

    Fare levels, service assumptions and the joint solution are set out in full in the PDF brief, including the two equations solved simultaneously in §6.1.
  • At face value

    At Face Value

    Five numbers from ALTO’s economic report are now in wide circulation. Each one is either the top of a range or the middle of one. In every case the range exists. In every case it was not printed.

    ⚠ The numbers you will hear

    $49.5 billion in benefits · $24.5 billion in added GDP · 1.1 per cent of Canada’s economy · 50,000 jobs · 24 million riders a year

    None of these figures is invented. Every one comes from real modelling work by real economists, and each is accurate on its own terms. But each describes something narrower, or more conditional, than it sounds — and in every case the report prints one number where the work behind it reports a range.

    Critical Finding

    $49.5 billion is labelled an upper estimate — the good end of a range whose other end is nowhere in the document. $24.5 billion is a central estimate from a range its own modeller published as $14.8 billion to $41.0 billion. 24 million riders is prefixed “up to.” 50,000 jobs sits in a table headed “upper estimate” — and ALTO’s own appendix states those figures are not net economic gains.

    Meanwhile the report declines to publish a benefit-cost ratio — the single number that would tell you whether the benefits exceed the costs.

    The point of this brief is not that ALTO’s numbers are wrong. It is that they are being used as though they were settled, when the documents behind them show they are not.

    The document under examination
    Canada’s Moment: The Economic Opportunity of High-Speed Rail
    ALTO, August 2026 — 83 pages. All figures on this page are from that report or the studies it commissioned.
    Read ALTO’s report
    Number One

    “$49.5 billion in benefits”

    What you’ll hearWhat it actually is
    ALTO delivers $49.5 billion in benefits to Canadians. The upper estimate of benefits, added up over 60 years, adjusted downward for the fact that most of them arrive decades from now. Nearly four-fifths of it is saved travel time.
    In plain language — what “discounted” means

    Economists assume a benefit arriving in 2085 is worth less to us today than the same benefit arriving next year — the same reason $100 now beats $100 in twenty years. So future benefits get shrunk before they are added up. This is standard, required, and correct.

    It also does a great deal of work here, and the Initiative’s brief Hours Are Not Dollars sets it out in full. The report says ALTO saves 9.3 billion hours of travel time, and values an hour at $22.32. Multiply those together and you get $207.6 billion. The figure that appears in the benefit table is $38.4 billion. Discounting removes about 82 per cent of the face value, because most of those hours are saved by people who have not been born yet.

    In plain language — what “upper estimate” means

    The benefit table is headed “upper estimate.” Every narrative figure is prefixed “up to” — up to 24 million riders, up to 9.3 billion hours, up to 400 lives saved. An upper estimate is one end of a range. The other end does not appear anywhere in the 83 pages.

    There is one more thing about this number worth knowing. The report opens by making traffic congestion the problem — Highway 401, Pearson airport, journeys that are too slow and too unreliable. In the benefit table, easing congestion is worth $570 million out of $49.5 billion: about 1.2 per cent. Cleaner air is worth $27 million, roughly one part in two thousand.

    The problem the report leads with and the benefit the report counts are almost entirely different things.

    Number Two

    “$24.5 billion in added GDP”

    What you’ll hearWhat it actually is
    ALTO adds $24.5 billion to the Canadian economy. The middle of a range running from $14.8 billion to $41.0 billion, produced by a different model, in a different year’s dollars, and measured as an annual figure rather than a 60-year total.
    Can it be added to the $49.5 billion? No — the report says so on page 9

    The Initiative examined this figure in detail in Two Point Two Trillion. It is the number ALTO’s website states most confidently: the analysis “concludes that Alto will permanently uplift Canada’s GDP by 1.1%.” The study behind it is more careful, and it publishes its range.

    $14.8B
    the low end of the modeller’s published range
    Aviseo, Table 1
    $24.4B
    the baseline — the only figure that reached the public
    Aviseo, Table 1
    $41.0B
    the high end — nearly three times the low end
    Aviseo, Table 1
    In plain language — where this number comes from

    It comes from a computable general equilibrium model — a simulation of the whole Canadian economy that works out what happens to wages, prices, trade and output when you change one thing. These are legitimate, widely used tools. Governments run them all the time.

    The thing being changed here is a single assumption: that firms in Toronto, Montréal, Ottawa and Québec City become three per cent more productive because the train exists. That one assumption produces $21 billion of the $24.4 billion — 86 per cent of the total.

    In plain language — how three per cent was chosen

    The modellers say so openly, and deserve credit for it. Studies in Germany and Sweden found productivity gains of two to four per cent. So, they write, “it seems reasonable to consider a baseline scenario” of three per cent.

    They also tested two per cent and five per cent. Two per cent gives the $14.8 billion; five per cent gives the $41.0 billion. There is no scenario in which the productivity gain fails to appear at all — even the pessimistic case assumes a two per cent uplift across four city economies.

    One further detail. Because nobody yet knows where the stations will go, the modellers applied that productivity boost to the entire metropolitan areas of Toronto, Montréal, Ottawa and Québec City — standing in for the 30-kilometre radius around a station that the research actually supports. Peterborough, Laval, Trois-Rivières and Kingston appear nowhere in that calculation.

    Number Three

    “1.1 per cent of Canada’s GDP”

    What you’ll hearWhat it actually is
    ALTO raises Canada’s GDP by 1.1 per cent. 1.1 per cent of the Canadian economy as it was in 2019 — the last pre-pandemic year, used because 2020 and 2021 were distorted.

    The modeller says this plainly: the gain is “roughly 1.1% of Canada’s 2019 GDP.” Canada’s Moment drops the year. The website drops the year and adds the word “will.”

    Taken across the published range rather than the midpoint, the same calculation gives roughly 0.6 per cent at the low end and 1.8 per cent at the high end. One of those three numbers is in circulation.

    Number Four

    “50,000 jobs and $86 billion”

    What you’ll hearWhat ALTO’s own appendix says
    Building ALTO creates 50,000 jobs and adds $86 billion to GDP. These figures “represent spending-supported economic activity rather than net economic gains” and are “therefore not included in the benefit-cost ratio.”
    In plain language — why jobs numbers are not benefits

    If you spend $60 billion on anything — a railway, a bridge, a very large hole — people get paid to do it, and those people spend their wages locally. Counting that as a benefit of the project would mean any spending is a benefit, which cannot be right: the money had to come from somewhere, and would have employed someone else.

    ALTO’s appendix says this outright, and adds that the model used “does not account for potential constraints in the economy, such as labour shortages or capacity limits.” Most promoters present numbers like these as benefits and say nothing. ALTO explicitly refuses to — on page 80. The 50,000 jobs appear on page 5.

    The caveat is genuine and creditable. It sits in an appendix seventy-five pages behind the figure it qualifies, and it has not travelled with the number. The Initiative examines this figure in full in Where Do 50,000 Jobs Come From?, which rebuilds it from the annual spending and workforce figures HS2 and the Réseau express métropolitain both publish, and finds that roughly 18,000 of the 50,000 are people working on the railway.

    Number Five

    “24 million riders a year”

    What you’ll hearWhat it actually is
    ALTO will carry 24 million passengers a year. “Up to” 24 million a year by 2055 — the output of scenarios and sensitivity tests whose range the report describes but does not show.

    ALTO’s own methodology appendix explains exactly what it should have published. Sensitivity testing, it says, gives decision-makers “a range of plausible outcomes rather than relying on a single forecast.” The flowchart’s stated output is “a range of plausible ridership outcomes.”

    The report then prints one number.

    That number matters more than it looks, because four of the seven benefit lines depend on it — car running costs, road safety, congestion and greenhouse gases all flow from an estimate of 90.1 billion kilometres of driving avoided. And how much driving is avoided depends on who the new passengers are. Someone who switches from a car takes kilometres off the road. Someone who switches from a plane takes none. Someone making a brand new trip takes none. That breakdown is published nowhere.

    And One Number That Is Missing

    There is no benefit-cost ratio

    The standard test of whether a public investment is worth making is simple: divide the benefits by the costs. Above one, it pays. Below one, it does not.

    Canada’s Moment does not publish that number. Page 62 explains why: the cost estimate is too early-stage for the ratio to be meaningful. The same absence runs through ALTO’s public benefits page, examined in Many Benefits, One Missing Number.

    In plain language — what the cited manual says about early-stage uncertainty

    ALTO names a Metrolinx appraisal manual as the authority for two of its key figures — the subject of It Left the Rules Behind. That manual treats early-stage uncertainty as the reason to test and publish ranges — not as a reason to withhold them. Its instruction for the earliest project stage is to conduct sensitivity testing to understand the level of uncertainty.

    The same manual also requires early-stage rail costs to be marked up by 64 per cent before being compared with benefits, because rail megaprojects are systematically undercosted. That would put ALTO’s $60–90 billion into the comparison at roughly $98–148 billion. No such uplift is applied, and the concept is not mentioned.

    So the report does not divide the benefits by the costs, while placing $49.5 billion in benefits and $60–90 billion in costs on the same spread.

    It has been done before — on this corridor, at this stage

    In December 2021 the Joint Project Office — a body formed by VIA Rail Canada and the Canada Infrastructure Bank — completed a business case for High Frequency Rail, the slower and cheaper predecessor to ALTO along the same corridor. It was at a comparable point in its development.

    That document published a benefit-cost ratio.

    Project
    High Frequency Rail — the same Toronto–Québec City corridor, at a comparable stage of design
    Capital cost
    $27.71 billion in 2020 prices
    Benefit-cost ratio
    Approximately 0.13 — rising to about 0.4 on an expanded basis that also counts agglomeration effects and a resource correction
    Net present value
    −$21.1 billion over thirty years
    Public subsidy
    $37.1 to $42.2 billion over thirty years, under the delivery models assessed
    Parameters
    Drawn from Metrolinx and Ministère des Transports du Québec guidance — the same two sources Canada’s Moment cites five years later

    It was not published at the time. It became public in November 2025, when the Canada Infrastructure Bank released it under the Access to Information Act — almost four years after it was written.

    In plain language — what a ratio of 0.13 means

    A benefit-cost ratio of 1.00 means a project returns exactly what it costs. Above 1.00 it pays for itself in economic terms; below 1.00 it does not.

    A ratio of 0.13 means that for every dollar spent, about thirteen cents of measurable benefit came back. On the wider basis, which counts effects that are harder to measure, about forty cents. The Joint Project Office published those figures anyway, alongside the subsidy the project would need.

    Read this part carefully — these are not ALTO’s numbers

    0.13 is not ALTO’s ratio, and it is not an estimate of ALTO’s ratio. High Frequency Rail was a different project: slower, at $27.71 billion rather than $60–90 billion, assessed over thirty years rather than sixty. The Joint Project Office described its own results as preliminary. None of its figures transfers to ALTO by arithmetic, and this brief does not offer them as a forecast of anything.

    What the document establishes is narrower, and harder to answer: a benefit-cost ratio can be produced for a project on this corridor at this stage of design — because one was. Immaturity did not prevent it then, on a cost estimate roughly a third the size.

    There is one further detail worth recording. The same document, released under a different access request, comes back with one section withheld in full, the capital cost and revenue sentences cut off mid-clause, and the subsection headings of its Economic Case not shown in the table of contents. No exemption provision is marked against any of these.

    What Cannot Be Checked At All

    The benefit table cannot be audited by a reader

    Each row of the main benefit table gives you a quantity and a dollar value. The natural thing to do is divide one by the other and see what price has been put on an hour, a tonne of carbon, or a life. You cannot.

    The dollar figures are discounted. The quantities are not. And the prices that would connect them are referenced by source but never stated — only the $22.32 hourly value appears anywhere.

    One row does not appear to add up at all. The report says ALTO avoids up to 400 deaths and 26,000 injuries, valued at $610 million. Working backwards, that is roughly $1.2 billion before the time adjustment — which 26,000 injuries alone would exhaust at $50,000 each, a low figure by Canadian standards, leaving nothing for the 400 lives. Either the casualty counts and the money cover different periods, or the values placed on a life and an injury are far below what Canadian governments normally use. The report does not publish enough to say which.

    The Takeaway

    The same thing has happened to every number

    Top of a range
    $49.5 billion in benefits — the table is headed “upper estimate”; the lower estimate is nowhere in the document.
    Middle of a range
    $24.5 billion in GDP — the modeller published $14.8 billion to $41.0 billion. Only the midpoint travelled.
    Top of a range
    24 million riders — prefixed “up to,” from a process whose stated purpose is to produce a range.
    Top of a range
    50,000 jobs — in a table headed “upper estimate,” for figures the appendix says are not net gains.
    Not published
    The benefit-cost ratio — the one number that would put the others in proportion. The last time one was produced for this corridor, it took an access-to-information request to see it.

    This is the finding. Not that any figure is fabricated — none is. Not that the modelling is incompetent — the underlying studies are careful, and say so about their own limits. But wherever the underlying work reported a range, the document carries a single figure from the optimistic end of it, and it is that single figure which has reached councils, newspapers and the public.

    The ranges are not secret. Most of them are in ALTO’s own commissioned studies, sitting on ALTO’s own research page. They simply did not make it into the document that everyone reads.

    None of these figures should be repeated at face value, in either direction. They are the optimistic end of work that its own authors describe as uncertain — and anyone quoting them, for or against the project, should say which end of the range they are quoting.

    In Fairness

    What this brief is not saying

    Credit where it is owed

    The modellers were transparentThe economic study behind the GDP figure publishes its full range, states its assumptions, and explains how each was chosen. This brief is only possible because that work was published.
    ALTO refuses a claim it could have madeIts appendix states that the construction jobs and spending figures are not net economic benefits — a caveat most promoters simply omit.
    Some choices are genuinely cautiousThe value of an hour is held flat for 60 years rather than rising with incomes, which lowers the benefit total substantially. Safety benefits are capped after 20 years.

    And the limits of what we show

    Some arithmetic here is oursEvery figure attributed to ALTO, Aviseo, Metrolinx, the Joint Project Office or Transport Canada is quoted from the source listed below and can be checked there. Everything else is our own calculation from those published inputs: the $207.6 billion undiscounted time total, the 82 per cent that discounting removes, the 0.6 and 1.8 per cent at the ends of the GDP range, the $98–148 billion uplifted cost, and the casualty reconciliation. The reconciliations use assumptions about timing that ALTO does not disclose. They show the numbers cannot be reproduced from what is published — not that they are wrong.
    This is about disclosure, not competenceThe underlying modelling may be entirely sound. The objection is that a reader cannot tell, because the working is not shown.
    We do not say whyWhere a range or a caveat does not appear in the report, this page says so rather than inferring it. It makes no claim about why any particular figure was or was not published.
    A range is not a refutationThat the GDP figure could be $14.8 billion does not mean it will be. It equally could be $41.0 billion. The point is that one number is being presented as though the others do not exist.
    What To Ask

    Five questions for anyone quoting these figures

    1. Is that the top of the range, or the middle?

    For four of the five headline numbers, it is one or the other.

    2. What is the lower estimate?

    The benefit table is explicitly labelled an upper bound. Every range has another end.

    3. What is the benefit-cost ratio?

    Not published. It is the number that puts every other number in proportion — and one was produced for this corridor in 2021, so “too early” is a choice rather than a constraint.

    4. What price was put on a life, or a tonne of carbon?

    Referenced by source, never stated. Without them, no line of the benefit table can be checked.

    5. Where do the new passengers come from?

    Cars, planes, existing trains, or trips that would never have happened? A fifth of the benefits depend on the answer.

    Sources

    Primary documents

    1.
    ALTO, Canada’s Moment: The Economic Opportunity of High-Speed Rail, August 2026, 83 pp. Benefit table and value of time at p. 72; cost-benefit methodology at p. 73; GDP table and its “central estimate” note at p. 75; the roughly 100 simulations at p. 78; input-output caveat at p. 80; construction figures at Table A4, p. 81; ridership methodology at pp. 81–83; benefit-cost ratio at p. 62; non-additivity of the models at p. 9. altotrain.ca (PDF)
    2.
    Aviseo Conseil, An Overview of the Structural Economic Impacts of Alto: Computable General Equilibrium Modelling Approach, June 2026, 25 pp. Prepared on behalf of Alto. Published range at Table 1; productivity scenarios at Shock 1; labour-supply scenarios at Shock 2; geography assumption at p. 10. Available on ALTO’s research page.
    3.
    Metrolinx, Business Case Manual Volume 2: Guidance, August 2021, 222 pp. Cited by ALTO as the source of its discount rate and value of time. Sensitivity requirements at pp. 87–89; optimism-bias uplift at pp. 90–94; economic parameters at Table 5.8, p. 98.
    4.
    Joint Project Office (VIA Rail Canada and the Canada Infrastructure Bank), High Frequency Rail Project: Business Case Update, V.002, 10 December 2021, 150 pp. Released by the Canada Infrastructure Bank under the Access to Information Act, November 2025. Capital cost at p. 7; benefit-cost ratio, net present value and subsidy comparison at p. 8; appraisal parameters sourced to Metrolinx and MTQ guidance at p. 40; impact results and both ratios at Table 14, p. 43. The same document released as Annexe A to access request 22-2207 withholds section 9.7 in full, truncates the capital cost and revenue sentences mid-clause, and withholds the subsection headings of the Economic Case within its table of contents, with no exemption provisions marked.
    5.
    Transport Canada, Statistics on the social costs of collisions in Canada, and the underlying Ontario social cost model — used here as the comparison for standard Canadian casualty valuations. ALTO does not cite these and may have used others.
  • Hours are not dollars

    Hours Are Not Dollars

    Almost none of ALTO’s $49.5 billion is money. It is time — and a saved hour cannot service a loan. Here is what that figure actually is, how it was built, and why it says nothing about who pays for the railway.

    ⚠ Where the Number Sits

    In August 2026 ALTO published Canada’s Moment: The Economic Opportunity of High-Speed Rail, reporting $49.5 billion in benefits against a construction cost of $60 to $90 billion. Those benefits are not money in a bank account. They are mostly hours — time that travellers would have spent on the road or at an airport — stretched over sixty years and converted into today’s dollars.1

    The tool that does the converting is called a discount rate. ALTO uses 3.5 per cent a year. Change that one number and the headline changes by tens of billions, without a single train or passenger changing.

    In One Paragraph

    The $49.5 billion is a measure of worth, not of funds. The tool that produces it, a discount rate, answers the question is this worth doing? It does not answer the question who pays, and how? Those are separate ledgers, and ALTO’s report is detailed on the first and thin on the second. This explainer sets out what the rate does, shows the arithmetic openly, and then follows the money to the place the appraisal never goes: the difference between what it costs the government to borrow and what a private partner needs to earn.

    One finding runs against the grain and is stated here first. Two of the adjustments ALTO leaves out would have made its benefit figure larger, not smaller. The problem is not that the number is tilted. The problem is that a reader is given one number, no range, and no way to know that any of these choices were made.

    Start Here

    What a discount rate is, in ordinary words

    Ask yourself a simple question. Would you rather have $100 today, or $100 in forty years? Almost everyone takes it today. The money is useful now, the future is uncertain, and by 2066 we will probably all be somewhat better off anyway, so $100 will matter a little less to us then than it does now.

    Economists turn that instinct into a percentage. A discount rate shrinks future amounts back to what they are worth to us today, by a fixed amount each year. At 3.5 per cent, a benefit arriving sixty years from now counts for about 13 cents on the dollar. At 8 per cent, the same benefit counts for about one cent.

    That is the whole mechanism. It sounds technical and it is arithmetically simple. But it matters enormously for a railway, because of when the money and the benefits arrive.

    13¢
    what a dollar of benefit in year 60 is worth today at ALTO’s 3.5 per cent
    23¢
    the same dollar at 2.5 per cent, the rate ALTO’s own cited manual requires be tested
    1¢
    the same dollar at 8 per cent, the rate identified in 2007 Treasury Board guidance

    The timing is what makes this decisive. Construction money is spent early — from 2029 through the early 2040s — so it is barely shrunk at all. The benefits arrive later and keep arriving for sixty years, so they are shrunk heavily. Anything that changes the rate therefore hits the benefit side hard and the cost side hardly at all. A project’s whole case can move from comfortable to marginal without anything physical changing.

    The Arithmetic, Shown Openly

    How much the answer moves

    The table below is the Initiative’s own arithmetic, not a re-run of ALTO’s model. It takes a steady stream of benefits running for sixty years, beginning fifteen years from now, and asks what that stream is worth in today’s dollars at different rates. The last column simply scales ALTO’s published $49.5 billion by the same proportion, to show the size of the swing.

    Discount rate usedValue of the streamRelative to 3.5%$49.5B scaled
    2.5 per cent21.341.43×$71.0B
    3.0 per cent17.761.19×$59.1B
    3.5 per cent — ALTO’s rate14.891.00×$49.5B
    UK declining schedule15.611.05×$51.9B
    5 per cent9.110.61×$30.3B
    7 per cent5.090.34×$16.9B
    8 per cent3.900.26×$13.0B

    Assumptions, stated so the arithmetic can be checked: a level benefit stream of one dollar per year, sixty years of operation beginning in year 16, discounted back to a year-zero base. ALTO’s real benefit stream ramps up rather than running level, so the exact figures would differ; the proportions are what matter here. The scaled column is illustrative and is not ALTO’s number at those rates.

    Read the middle rows first. At 8 per cent, the same railway carrying the same passengers saving the same hours produces a benefit figure roughly a quarter the size. At 2.5 per cent it produces one roughly forty per cent larger. Nothing about the trains changed. Only the parameter changed.

    This is why appraisal manuals require the calculation to be repeated at more than one rate and the results published as a range. It is not a bureaucratic formality. It is the only way a reader can tell whether a case is robust or whether it depends on a parameter choice.

    Where 3.5 Per Cent Comes From

    A number with a family tree

    ALTO’s report attributes its rate to one source: the Business Case Manual Volume 2: Guidance, published by Metrolinx, the Government of Ontario’s transit agency for the Toronto and Hamilton region.2 That manual sets a social discount rate of 3.5 per cent, alongside an evaluation period of five to sixty years.

    The 3.5 per cent figure is not original to Metrolinx. It is the rate used by HM Treasury in the United Kingdom, and the Treasury publishes exactly how it was assembled. Three judgements are added together:

    0.5 per cent for simple impatience. People prefer good things sooner. Half a percentage point is the allowance for that.

    1.0 per cent for the risk that the future does not arrive as expected. Wars, pandemics, collapses. A benefit promised in 2080 might never materialise, so it is discounted a little further.

    2.0 per cent because people in the future will be richer. If incomes rise about 2 per cent a year, our grandchildren will be considerably better off than we are, and an extra dollar will matter less to them than it does to us. This is the largest of the three, and the most contestable.

    Those three add to 3.5.3

    Notice what the rate is not. It is not a market price, an interest rate, or anything anyone can look up. It is a set of judgements about how much weight to give people who are not yet born — and every one of the three is disputed by serious people. That is not a criticism of the figure. It is the reason a serious appraisal shows what happens when the figure moves.

    The detail that cuts in ALTO’s favour

    HM Treasury does not apply 3.5 per cent forever. The rate steps down to 3.0 per cent for years 31 to 75, and 2.5 per cent thereafter,3 and the Treasury’s supplementary guidance instructs practitioners in the same terms: the standard 3.5 per cent for years 1 to 30, and 3.0 per cent for years 31 to 75.4 The reason is uncertainty: the further out you look, the less confident anyone can be in the parameters, and the lower the rate should be.

    ALTO discounts a sixty-year stream at a flat 3.5 per cent throughout. Applying the stepped-down schedule instead would have made ALTO’s benefit total about five per cent larger, as the fourth row of the table above shows. This is a conservatism in ALTO’s favour, and it should be credited as one. It is recorded here because a reader assessing where a federal appraisal input came from deserves the whole picture, including the parts that do not fit a critical narrative.

    The Canadian Comparison

    What the federal government uses, and the gap where a manual should be

    Canada has approached the same question from the opposite end, and it is worth understanding the difference, because it produces a far higher number.

    The British method asks a question about values: how much should we care about the future? The Canadian method asks a question about alternatives: what else could this money have done? If public money invested elsewhere in the economy would have earned, say, 8 per cent, then a project has to clear that bar to be worth funding — otherwise the country was better off doing the other thing. That is what economists mean by the opportunity cost of capital.

    Neither question is wrong. They are simply different questions, and the second one produces a much tougher test than the first.

    The Treasury Board’s 2007 guidance identified 8 per cent as the appropriate rate, with sensitivity tests at 3 and 10 per cent, on that opportunity-cost basis.5 The current federal Policy on Cost-Benefit Analysis still directs departments to use the opportunity cost of capital as the discount rate, permitting a social rate only in defined cases — including where impacts run fifty years or more — and requiring that even when a social rate is used, results using the opportunity cost of capital must also be reported.6

    Two honest qualifications belong here, and neither is small. First, that federal policy governs regulations, not capital projects, so it does not bind ALTO. Second, the current edition of the Treasury Board guide is no longer published on canada.ca and is available only through an internal government wiki page,7 so the Initiative has not been able to verify the figure it now specifies.

    And the federal manual for transport projects specifically? Transport Canada’s guide to benefit-cost analysis dates from 1994.8 Thirty-two years later, there is no current, public federal appraisal manual for a project of this kind. That absence is very likely why a national railway is being appraised using a provincial transit agency’s parameters — and it is a finding about the machinery of government rather than about ALTO.

    Even the academic case for 3.5 per cent has conditions

    The most cited Canadian argument for a 3.5 per cent rate comes from the economists Boardman, Moore and Vining, who reject the 8 per cent approach. So there is a respectable Canadian case for ALTO’s rate. But it is a conditional case, and the conditions are specific.

    Condition one: the project runs under fifty years. Beyond that, they recommend a rate that steps down over time, for the same reason the UK Treasury does — nobody can see that far ahead with confidence.

    Condition two: the project must not pull money away from private investment. The money for a public project comes from taxes or borrowing, and it would otherwise have been used by someone else. Some of it would have been spent, and some would have been invested — a business expansion, new equipment, a factory. Those two are not equivalent. A dollar diverted from someone’s spending costs the economy that one dollar. A dollar diverted from investment costs more, because that investment would have gone on producing returns for years afterwards.

    And if the project does pull money from investment, there is a fix. Rather than argue about the rate all over again, you take the portion of the cost that displaced private investment and mark it up by 26 per cent before putting it in the calculation — because that is roughly what the lost investment was worth to the economy over time. Economists call the 1.26 multiplier a shadow price of capital. It is simply a way of using a generous discount rate honestly, instead of using it to pretend the money was free.5

    ALTO’s appraisal period is sixty years, which fails the first condition outright. Whether a $60 to $90 billion draw on Canadian capital displaces private investment is a real question, not a technicality — and the mark-up would apply only to the share that does, not to the whole sum. Neither condition is mentioned in the report.

    The pattern is the one the companion audit It Left the Rules Behind describes: a number travels, and the conditions attached to it stay behind.

    The Precedent

    The last time anyone published these numbers for this corridor

    ALTO’s stated reason for publishing no benefit-cost ratio is that the cost estimate is not yet mature enough to support one. It is worth knowing that a predecessor project on the same corridor did publish one, at a comparable stage, and published the funding ledger alongside it.

    In December 2021 the Joint Project Office — a body formed by VIA Rail and the Canada Infrastructure Bank — completed a Business Case Update for High Frequency Rail, the slower, cheaper predecessor to ALTO between Toronto and Québec City. It was released through access to information by the Canada Infrastructure Bank in November 2025.16

    What the 2021 business case publishedFigure
    Capital cost, with electrification (2020 prices)$27.71B
    Projected revenue over 30 years (2019 prices)$33.7B
    Operations, maintenance and rehabilitation, 30 years$32.5B
    Net present value over 30 years−$21.1B
    Benefit-cost ratio~0.13
    Expanded benefit-cost ratio~0.4
    Public subsidy over 30 years, by delivery model$37.1B to $42.2B

    Source: Joint Project Office, High Frequency Rail Business Case Update V.002, 10 December 2021. Ratios at Table 14, page 43; capital, revenue, lifecycle and net present value figures in the executive summary, pages 7 and 8; subsidy comparison at Table 4, page 8.

    A benefit-cost ratio of 0.13 means about thirteen cents of measured benefit for every dollar of cost. The wider figure of 0.4 is what the same table calls an expanded ratio, and the difference between the two is worth understanding, because it is the larger of the two numbers.

    The expansion adds two items. One is agglomeration — the economic gain from businesses being better connected — worth $0.3 to $0.9 billion. The other, worth $5.6 to $7.6 billion, is a resource correction: the fares new passengers would pay, counted as a benefit because they arrive as revenue for the operator. That single item is larger than the journey time savings and all the external benefits put together. The business case itself notes that both are relatively new to Canadian economic appraisal, which is why it reports the ratio with and without them.

    The same two sources, five years apart

    The 2021 economic case states where its parameters came from: the social discount rate, the value of time and the value of external impacts were taken from a combination of Metrolinx and Ministère des Transports du Québec guidance. Those are the same two sources ALTO cites in 2026.

    So the identical parameter lineage, applied to a $27.71 billion version of this corridor, produced a published ratio of 0.13. Five years later, on a project costing two to three times as much, the same two sources are cited and no ratio is published at all.

    And it kept the two ledgers apart

    The 2021 document also shows how the distinction this page has been drawing is meant to work in practice. Its net present value calculation used a discount rate of 2.5 per cent, sourced explicitly to the ten-year average of the 30-year Government of Canada benchmark bond — a financing rate, taken from what the government actually pays to borrow. Its economic case used the social parameters from Metrolinx and MTQ. Two questions, two rates, both disclosed, in a single document.

    Three cautions, stated plainly. High Frequency Rail is not ALTO: different technology, different speed, a $27.71 billion cost rather than $60 to $90 billion, and a thirty-year evaluation rather than sixty. The JPO described its own results as preliminary. And none of these figures transfer to ALTO by arithmetic. What the document establishes is narrower and harder to set aside: a benefit-cost ratio can be produced for a project on this corridor at this stage of development, because one was.

    One further point belongs on the record. The identical document was also released under a separate access request, and in that version the whole net present value section, the capital cost figure, the revenue figure and both ratios were blacked out — along with the subsection titles of the Economic Case within the table of contents, and the construction employment figure in the executive summary. No exemption provision is marked against any of it.17 Same document, same date, two releases, opposite outcomes.

    Following the Money

    Three different rates, and only one of them is in the report

    Here is the heart of it. People use the phrase “the discount rate” for three quite different things, and conflating them is how an appraisal result gets mistaken for a financing plan.

    1. The appraisal rate — 3.5 per cent

    Used to decide whether a project is worth doing. No money moves because of it. It turns hours saved and collisions avoided into a single present-day figure so they can be compared with the cost. Nobody charges it, nobody pays it, and no bank uses it.

    2. What it costs the government to borrow

    Real money, actually paid. When the federal government borrows for thirty years it has been paying in the region of 3.7 to 3.9 per cent during 2026. Take off inflation, which the Bank of Canada aims to hold at 2 per cent, and the true cost of the money is roughly two per cent a year.9 If the state simply builds the railway and holds it, this is what the borrowing actually costs, and it is lower than the appraisal rate.

    3. What a private partner needs to earn

    Considerably more. If a pension fund or infrastructure investor builds the railway, it is putting its own money at risk — the risk that construction costs more than planned, or that too few people ride. It requires a return for carrying that risk, and that return is paid out every year for decades. This is the rate that decides what the public actually hands over, and it appears nowhere in ALTO’s economic report.

    The gap between the second and the third is the entire public-private question. If the government borrows at 2 per cent and builds the railway itself, that is what the money costs. If a private partner builds it instead and needs 8 per cent, someone has to make up the difference — every year, for as long as the arrangement lasts. That someone is the public.

    So a project can pass the 3.5 per cent test comfortably and still require very large annual public payments to get built. The appraisal will go on saying “worth doing.” It will never say who writes the cheque, for how long, or at what return.

    Why the $49.5 billion cannot pay for anything

    This is the point most easily missed, and it is not a technicality. Nearly all of ALTO’s benefit figure is not cash. It is hours of travel time, collisions that did not happen, tonnes of emissions avoided. These are real and they matter. But a saved hour cannot service a loan, meet a payroll, or renew a worn rail.

    The money that actually funds a railway comes from two places only: fares, and government payments. ALTO’s report handles that second ledger in a few pages, supported chiefly by the operating margins of three foreign railways, and it publishes no fare, no revenue figure and no farebox recovery ratio. So the document is expansive about whether the project is worth doing and close to silent about how it would be paid for.

    A Canadian Example, Fully Documented

    How the Montréal REM is actually funded

    The Réseau express métropolitain is a 67-kilometre automated light metro in Greater Montréal, built, owned and operated by CDPQ Infra, a subsidiary of the Québec pension fund manager. It is the clearest Canadian illustration of what the third rate looks like once it becomes money, and its terms are public.10

    Who put up the capital
    CDPQ Infra $2.95B; the Government of Québec $1.283B; the Government of Canada $1.283B; Hydro-Québec $295M; the regional transit authority $512M. The construction estimate rose from $6.3 billion in 2018 to $7.95 billion by 2023, an increase CDPQ Infra absorbed under its agreement.11
    How the money returns
    Not through fares. The regional transit authority pays CDPQ Infra 72 cents for every kilometre every passenger travels, indexed annually to the Consumer Price Index. That single rate covers construction, operation and long-term maintenance.12
    If ridership beats forecast
    The rate steps down. CDPQ Infra has described trips beyond 15 per cent above forecast being paid at roughly 57 cents, and trips beyond 40 per cent above forecast at the user fare itself.13
    The two return targets
    8 to 9 per cent for CDPQ Infra. 3.7 per cent for the governments. Both were set at the outset and publicly reaffirmed during construction.14

    That pair of numbers is the whole point of this section, made concrete. The same railway, the same track, the same passengers — and two participants requiring returns that differ by more than double. The difference is not a rounding error in an appraisal. It is paid out, in cash, on every passenger-kilometre, for as long as the agreement runs.

    Why this case and not another. The REM is not an analogy picked at random. CDPQ Infra leads Cadence, the consortium selected in February 2025 as ALTO’s private development partner. AtkinsRéalis — formerly SNC-Lavalin, a member of the group that built the REM and, with Alstom, of the group that supplies and operates its trains — is also a Cadence member. The other Cadence members are SYSTRA Canada, Keolis Canada, SNCF Voyageurs and Air Canada.18 The REM is the lead sponsor’s own model, which CDPQ Infra presents publicly as an innovative approach to delivering public infrastructure. That is what makes it the most informative available guide to how a private partner’s return might be priced here.

    An important caution. ALTO is nonetheless not the REM, and this is not a prediction. Canada is to retain permanent ownership of the ALTO network, which was never the REM arrangement; the project is in a co-development phase running to 2029; and no payment mechanism has been disclosed. Cadence is a different group with different members and a different contract. The REM is offered as the one Canadian case where the arithmetic of a private partner’s return has been made public — which is exactly what has not yet happened for a project several times its size.

    Notice what a payment mechanism does with risk. Because CDPQ Infra is paid per passenger-kilometre, a shortfall in riders is a shortfall in its own revenue — the investor carries the demand risk. Under a different structure, where the public pays for the railway simply being available, a shortfall in riders changes nothing the partner receives and everything the public pays.

    Same railway, same disappointing ridership, opposite consequences. Which of those applies to ALTO has not been published.

    Limits of This Explainer

    What this does not claim

    On the rate

    3.5 per cent is not wrongIt is a mainstream, well-supported choice for long-lived public investment. This explainer does not argue that ALTO’s rate is too low.
    Two omissions favour ALTOBoth the stepped-down schedule and the sensitivity test its cited manual requires would have produced a larger benefit figure. The omissions do not all run one way.
    The arithmetic is illustrativeThe table uses a level benefit stream and a stated start year. It shows the shape of the sensitivity, not a recalculation of ALTO’s result.
    The 2021 ratios are not ALTO’sHigh Frequency Rail was a different and cheaper project assessed over thirty years, and its authors called the results preliminary. Those figures are cited as evidence that a ratio can be produced at this stage, not as an estimate of ALTO’s.

    On the comparisons

    Nothing here binds ALTOMetrolinx guidance, UK Treasury practice and federal regulatory policy carry no legal force over this project. They are offered as points of comparison, one of which ALTO chose to cite itself.
    The federal figure is unverifiedThe 8 per cent rate is documented from 2007 guidance through peer-reviewed sources. The current edition of that guide is not publicly posted, and the Initiative does not assert what it now specifies.
    We do not say whyWhere the report does not state something — a fare, a payment mechanism, a sensitivity test, a range — this page says so rather than inferring it, and makes no claim about why any figure was or was not published, or about the intentions of anyone who prepared it.
    This is a public report, not a business caseA submission to Cabinet in 2029 may contain material this document does not. What is examined here is what has been placed in public.
    What Would Settle It

    Two questions, answerable without releasing a model

    1. Who absorbs it if the passengers do not come?

    Not a forecasting question but a contract question. If a partner is paid per passenger, a shortfall reduces its return. If it is paid for availability, a shortfall costs the partner nothing and the public a great deal. Identical ridership, opposite outcomes — and ALTO has published neither the mechanism nor the cost of capital behind it.

    2. What fare, and what revenue?

    No fare level, average yield or farebox recovery ratio appears in eighty-three pages. Without one, the funding question cannot be examined by anyone outside the project.

    Neither requires access to ALTO’s models, cooperation from its staff, or agreement about what the correct discount rate for a national railway ought to be. Both are answerable from work already done.

    A third question — whether the calculation was ever run at any rate other than 3.5 per cent — belongs to the companion audit It Left the Rules Behind, which sets out the full list of tests the cited manual requires at this project’s scale and which of them appear in the report.

    Sources

    Primary documents

    1.
    ALTO, Canada’s Moment: The Economic Opportunity of High-Speed Rail, August 2026, 83 pp. Discount rate, sixty-year appraisal period and price base in the Appendix A methodology box, sourced at footnote 65 to the Metrolinx manual; capital cost and AACE Class 5 estimate at pp. 5 and 65; direct-benefit tables headed “upper estimate”. Analysed in full in the Initiative’s companion brief Two Parameters, None of the Conditions, summarised at It Left the Rules Behind.
    2.
    Metrolinx, Business Case Manual Volume 2: Guidance, August 2021, 222 pp. Economic parameters at Table 5.8: social discount rate 3.5 per cent, evaluation period five to sixty years, single blended value of time. Verified as the current edition, 21 August 2026. metrolinx.com
    3.
    HM Treasury, Review of discounting in the Green Book: Terms of Reference, 16 December 2025. Sets out the derivation of the 3.5 per cent Social Time Preference Rate. The Treasury specifies four parameters — pure time preference, catastrophe risk, the elasticity of marginal utility and the growth rate — the last two of which multiply to the 2.0 per cent component described above as a single judgement. and the declining schedule of 3.0 per cent for years 31 to 75 and 2.5 per cent thereafter. gov.uk
    4.
    HM Treasury, Green Book supplementary guidance: discounting, updated 5 February 2026. Instructs practitioners to use 3.5 per cent for years 1 to 30 and 3.0 per cent for years 31 to 75. gov.uk (PDF)
    5.
    A. E. Boardman and M. A. Moore, “The Social Discount Rate for Canada Based on Future Growth in Consumption,” Canadian Public Policy, vol. 36 no. 3 (2010), pp. 325 onward. Records the Treasury Board Secretariat’s 2007 interim recommendation of an 8 per cent social discount rate with sensitivity rates of 3 and 10 per cent on a weighted social opportunity cost of capital basis; argues instead for 3.5 per cent, conditional on a horizon under fifty years and no crowding out of private investment, with a shadow price of capital of 1.26 applied to investment flows, and a declining schedule beyond fifty years. Canadian Public Policy
    6.
    Treasury Board of Canada Secretariat, Policy on Cost-Benefit Analysis, in force since 1 September 2018. Requires departments to use the opportunity cost of capital specified in the TBS guide, with a social discount rate permitted in defined cases including impacts of fifty years or more, and requires opportunity-cost results to be reported in any event. canada.ca
    7.
    Treasury Board of Canada Secretariat, “Requirements for developing, managing and reviewing regulations,” canada.ca, page updated 26 November 2025, accessed 21 August 2026. States that the most current version of Canada’s Cost-Benefit Analysis Guide for Regulatory Proposals is available exclusively on the Cabinet Directive on Regulation GCwiki page. The 2022 edition remains catalogued in Government of Canada Publications as an archived document. canada.ca
    8.
    Transport Canada, Economic Evaluation Branch, Guide to Benefit-Cost Analysis in Transport Canada, Ottawa, 1994. Catalogued in the Transport Research International Documentation database. TRID
    9.
    Bank of Canada, selected benchmark bond yields, accessed August 2026; Bank of Canada policy interest rate held at 2.25 per cent through mid-2026 against a 2 per cent inflation target. Long-bond yields move daily and should be checked against the source rather than quoted from this page. bankofcanada.ca
    10.
    Réseau express métropolitain, “Information about the agreement with the ARTM and its rate mechanisms.” Sets out the 72-cent per passenger-kilometre invoice to the regional transit authority, the reduction once ridership projections are exceeded, and the turnkey scope covering construction, operation and long-term maintenance. rem.info
    11.
    Capital structure as reported on award of the construction contracts: CDPQ Infra $2.95B, Government of Québec $1.283B, Government of Canada $1.283B, Hydro-Québec $295M, ARTM $512M, against a construction cost of $6.3B. The estimate was revised to $7.95B in September 2023, with CDPQ Infra absorbing the increase under its agreement with the Québec government. International Railway Journal
    12.
    Gouvernement du Québec, ARTM and CDPQ Infra, “Release of the management and implementation agreement and of the integration agreement for the Réseau express métropolitain,” 23 April 2018. Confirms the $0.72 per passenger-km base cost and annual indexation to Canada’s Consumer Price Index, and the cap limiting additional municipal costs to roughly $45 to $60 million a year in then-current dollars. quebec.ca
    13.
    CDPQ Infra, “7 myths about the REM de l’Est,” February 2022. Describes the ridership relief mechanism: the rate falls by about 20 per cent, to roughly $0.57, for trips above 15 per cent over forecast, and equals the user fare for trips above 40 per cent over forecast. Published in the context of a later project; the mechanism described is the REM’s. cdpqinfra.com
    14.
    Réseau express métropolitain, semi-annual project update, 3 June 2021. Reaffirms the 72-cent rate set in the 2018 agreement and states the performance targets: 8 to 9 per cent for CDPQ Infra and 3.7 per cent for the government partners. rem.info
    15.
    Discounting arithmetic in this explainer computed by the Initiative on the stated assumptions: a level annual benefit stream, sixty years of operation beginning in year 16, discounted to a year-zero base; the declining-schedule row applies 3.5 per cent to years 1 to 30, 3.0 per cent to years 31 to 75, per source 3.
    16.
    Joint Project Office (VIA Rail Canada and the Canada Infrastructure Bank), High Frequency Rail Project: Business Case Update, V.002, 10 December 2021, 150 pp., released by the Canada Infrastructure Bank under the Access to Information Act, November 2025. Capital cost breakdown and 30-year revenue at p. 7; benefit-cost ratio, net present value and the Table 4 subsidy comparison at p. 8; economic appraisal parameters sourced to Metrolinx and MTQ guidance at p. 40; incremental capex and opex at Table 9; other impacts at Table 12; impact results and both ratios at Table 14, p. 43; net present value assumptions, including the 2.5 per cent discount rate sourced to the ten-year average 30-year Government of Canada benchmark bond, at Figure 38, p. 85.
    17.
    The same document released as Annexe A to access request 22-2207 (148 pp., stamped Demande d’accès à l’information #22-2207 AI(D)). In that version, section 9.7 Net Present Value Analysis survives as a heading at p. 84 with pp. 84–86 otherwise blank; section 9.8 Financial Structuring at p. 87 is withheld in full; the capital cost and 30-year revenue sentences are truncated mid-clause at p. 21, leaving the grammar intact around the removed figures; and the subsection headings of section 7 Economic Case are withheld within the table of contents, together with the title of section 8 and all of its subsections, which appear as bare dot leaders against pp. 40–43 and 44–63. The construction employment sentence at p. 21 is severed in the same way: “an estimated ___ annual equivalent jobs could be created.” That figure — 71,000 to 96,000 annual equivalent — is disclosed in full in the Canada Infrastructure Bank release at note 16. No exemption provisions are marked against any of the severed passages. Both versions held by the Initiative.
    18.
    Cadence consortium membership and CDPQ Infra’s leadership role: Cadence, “About us,” and CDPQ Infra, “Alto high-speed rail,” both accessed August 2026; consortium announced as preferred private development partner 19 February 2025, co-development agreement signed March 2025. AtkinsRéalis (formerly SNC-Lavalin) was a member of NouvLR, which held the REM engineering, procurement and construction contract, and of the group now operating as Pulsar with Alstom under the rolling stock, systems, operations and maintenance contract. cadence.info
  • It left the rules behind

    ALTO Used the Rulebook’s Numbers. It Left the Rules Behind.

    ALTO’s new economic report takes two key figures from an Ontario appraisal manual and names that manual as its source. The manual attaches conditions to those figures. The report uses the figures and leaves the conditions out.

    ⚠ The Document Under Examination

    In August 2026 ALTO published Canada’s Moment: The Economic Opportunity of High-Speed Rail, an 83-page report setting out the economic case for the Toronto–Québec City high-speed rail corridor. Its central figure is $49.5 billion in benefits to travellers and society, set against a construction cost of $60 to $90 billion.

    To turn sixty years of future benefits into one number in today’s dollars, the report needs two things: a rate at which to shrink future benefits back to present value, and a price for an hour of a traveller’s time. For both, it names one source — a public appraisal manual published by Metrolinx, the Government of Ontario’s transit agency for the Toronto and Hamilton region.

    Critical Finding

    The Metrolinx manual does not simply publish those two numbers. It publishes them as part of a package. For any project over $500 million, the same manual requires that the numbers be re-tested at different values, that results be reported as a range rather than a single figure, that early-stage construction costs be topped up to correct for known optimism, and that the project’s benefit-to-cost ratio be published. ALTO’s project is roughly a hundred times larger than that threshold.

    None of those requirements appears in ALTO’s report. There is no test of the discount rate, no range around the $49.5 billion, no optimism adjustment to the cost, and no benefit-cost ratio. The two numbers were carried across. The conditions attached to them were not.

    This brief does not argue that ALTO used the wrong discount rate. The rate it used is a mainstream, defensible choice. The finding is narrower and, we think, harder to answer: the report presents a set of choices as though they were simply facts, and a reader has no way of knowing that anything was chosen at all.

    Download
    Two Parameters, None of the Conditions — Full Brief (PDF)
    Full research brief with page references, parameter tables, and sources
    Download PDF
    Start Here

    Why this matters

    Imagine a builder quotes you a price for an extension. Asked where the figures come from, they name the standard industry pricing guide. That guide does set those rates. It also says that on a job this size the quote must show a high and a low figure rather than a single number, must add a fixed percentage on top because early quotes are almost always too low, and must set the total against the value of what you are getting.

    The builder uses the guide’s rates and does none of the rest. The quote may well be sound. You have no way of telling — and nothing on the page tells you that anything was left out.

    That is the situation this brief describes. ALTO’s economic report takes two figures from a public appraisal manual and names that manual as its source. The same manual attaches a set of mandatory checks to those figures for projects of this size. The figures were used. The checks are absent, and their absence is not disclosed.

    It matters because of what rests on the result. The $49.5 billion benefit figure is the number now appearing in news coverage and public statements as the reason to build a railway costing $60 to $90 billion of public money, ahead of a federal decision in 2029. Presented as a single figure with no range, it reads as something measured. The report’s own tables call it an upper estimate.

    What the report gives you

    One benefit figure, $49.5 billion, built on a rate and an hourly value of time presented without explanation of where they came from or what else was possible. No range. No benefit-to-cost ratio.

    What its own cited source requires

    The same figures re-tested at different values, results published as a range with a confidence level, a 64 per cent top-up on early-stage construction costs, and the benefit-to-cost ratio reported.

    What that leaves a reader with

    No way to judge how firm the headline number is — and no indication in the document that this is a question worth asking.

    One thing this brief does not do: argue that the numbers ALTO chose are wrong, or that high-speed rail is a bad idea. The rate it used is a mainstream choice, and the one test the manual requires would, if anything, make the benefits look larger. The ask is simply that the tests be run and published, as the cited manual says they must be.

    The Two Numbers

    What the report borrowed, and from where

    3.5%
    the discount rate ALTO uses, taken from the Metrolinx manual
    Appendix A, footnote 65
    $22.32
    the value of one hour of a traveller’s time, the same figure for every trip
    justified as following Metrolinx method
    64%
    the top-up the same manual requires on construction costs at this stage of design
    not applied in the report

    The discount rate. A benefit that arrives in 2085 is not worth as much to us today as the same benefit next year. Economists handle this by shrinking future amounts back to a present-day value at a fixed annual percentage — the discount rate. ALTO uses 3.5 per cent a year, applied over a sixty-year period. The rate matters enormously: over sixty years, small changes to it move the headline benefit figure by billions.

    The value of time. Most of the $49.5 billion is not cash. It is hours — time that travellers would otherwise have spent on the road or waiting at an airport. To put a dollar figure on those hours, you have to decide what an hour is worth. ALTO uses $22.32, and applies the same figure to every trip: business or holiday, commuter or tourist. The report tells us its own ridership model did separate business from non-business travel, and that this distinction was set aside in favour of one blended figure.

    Where both come from. The footnote attached to the discount rate cites one document and one only: the Business Case Manual Volume 2: Guidance, published by Metrolinx in August 2021. The single blended value of time is defended on the grounds that it follows Metrolinx method. So a manual written for regional transit projects in the Toronto and Hamilton area is the published authority for how a national intercity railway has been appraised.

    Metrolinx guidance is not binding on a federal Crown corporation, and nothing here suggests otherwise. But a citation carries the terms of the thing cited. If you name a manual as your authority, it is fair to look at what else that manual says on the same page.

    The Manual’s Own Terms

    The numbers come as a set, not a menu

    The 3.5 per cent rate appears in a table of standard parameters. The text introducing that table is direct about their status: any departure from them has to be explicitly agreed during the work, with a clear justification recorded. It is a list of defaults you may leave, provided you say so. Below is how each of those defaults is treated in ALTO’s report.

    What the Metrolinx manual specifiesWhat ALTO’s report does
    Discount rate: 3.5 per cent. The rate at which future benefits are shrunk to present value.3.5 per cent. Adopted exactly as specified, and correctly footnoted to the manual.
    Status:Carried across
    Value of time: one blended figure. A single hourly value across all modes and all trip purposes, rather than separate values for business and leisure travel.One blended figure, $22.32. Adopted, and expressly justified by reference to the manual — in preference to the business and non-business split that ALTO’s own ridership model had already produced.
    Status:Carried across
    Growth cap: stop escalating benefits 30 years out. The manual caps growth in the inputs thirty years after the base year, expressly to reflect the fact that nobody can see that far ahead. User benefits are named as covered by the cap.Applied to two small lines, not the big one. Accident rates are capped after twenty years, and vehicle emission factors run to 2050. No cap is stated on travel-time benefits — which are 78 per cent of the total.
    Status:Applied selectively
    One price year throughout. All values discounted and escalated to a single common year, fixed at the start of the study, so that every figure in the document is in the same money.Two price years in one report. The appraisal and the capital cost are in 2024 dollars; the economy-wide GDP result is in 2019 dollars.
    Status:Not consistent
    Test the value of time at 0.75 per cent real growth. The manual’s base case assumes the value of an hour does not rise in real terms — but pairs that assumption with a required test of what happens if it does.Zero growth assumed; no test run. The assumption was carried across. The test that the manual attaches to the assumption was not.
    Status:Left behind

    One footnote on the money. Adjusting the manual’s 2021 value of time for inflation to 2024 gives roughly $21.40 — within a few per cent of ALTO’s $22.32. We are not claiming ALTO derived its figure that way, and ALTO does not say how it did. The point is simply that the figure sits where you would expect a Metrolinx-derived figure to sit, which makes the omission of the accompanying test harder to explain as an oversight.

    The Missing Tests

    What a project this size is supposed to publish

    The Metrolinx manual scales its requirements to the size of the project. Anything above $500 million is treated as large scale, and a specific list of tests and disclosures becomes mandatory. ALTO’s cost estimate is $60 to $90 billion — roughly a hundred times that threshold. Here is that list, and where each item stands in ALTO’s report.

    Re-run the numbers at a different discount rate

    The manual requires the calculation be repeated at 2.5 per cent so the reader can see how sensitive the answer is to the rate. Not done, and not mentioned. Note the direction here: the required test is at a lower rate, which would make the benefits look larger. Nothing in the manual supports an argument that ALTO’s rate is too generous. What it supports is the narrower point that the manual’s author expects the rate to be tested and the test to be shown.

    Re-run the numbers with a rising value of time

    Required at 0.75 per cent real growth per year. Not done.

    Run the costs and assumptions through a range analysis

    The manual requires costs and modelling assumptions be run thousands of times with the inputs varied, and the result reported as a range with a stated confidence level. Not done.

    Report the odds that the project is worth doing

    The manual asks specifically for the probability that benefits exceed costs. Not reported — the report publishes no benefit-cost ratio at all.

    Publish the standard indicators

    Net present value, benefit-cost ratio, capital utilisation, return on investment, internal rate of return. None published.

    Model low, medium and high growth scenarios

    Required, with the ridership growth rate stated for each. A ridership range is shown; the underlying growth scenarios are not stated.

    This is not a theoretical requirement

    The manual works the method through on a real example: an extension of the Yonge subway line in Toronto, at an early stage of design. A single cost estimate of $5.65 billion becomes a range of $6.16 to $6.84 billion, with the confidence level attached. The reader is shown a central figure, a spread, and how sure anyone is about it.

    That project is roughly one per cent the size of ALTO. On uncertainty, the manual ALTO cites tells its reader more about a subway extension than ALTO’s report tells its reader about a national railway.

    The Missing Lower Number

    The report concedes a range it never publishes

    The two tables carrying the entire $49.5 billion case are both headed with the words upper estimate. Every figure in the narrative is prefixed the same way: up to 24 million riders, up to 9.3 billion hours saved, up to 400 fatalities avoided, up to 39.1 million tonnes of emissions.

    An upper estimate is one end of a range. The other end does not appear anywhere in the document.

    The claim built on top of those figures goes further still. The report states that the benefits hold across a wide range of scenarios, and repeats the point in its conclusion. But demonstrating that a result holds across a range of scenarios is exactly what the missing sensitivity analysis does, and exactly what the cited manual requires be reported at this scale. The scenarios may well have been run. Their results are not shown.

    And the report clearly knows how to show them. Elsewhere in the same document, the ridership forecast comes with multiple scenarios and a published band around it. The economy-wide GDP figure rests on nearly a hundred separate model runs with the assumptions varied. Between a tested input and a tested output sits the largest single number in the report, presented as a single column of point estimates.

    The Optimism Adjustment

    A top-up the manual requires, and the report does not mention

    Early cost estimates for big infrastructure projects are, as a matter of record, too low. Not occasionally — routinely. The Metrolinx manual is explicit about the evidence behind this: in an international sample of 258 rail projects, ninety per cent were undercosted, by an average of forty-five per cent.

    The manual’s response is a mandatory top-up applied to the construction cost when it is compared with benefits, over and above whatever contingency is already in the estimate. The size of the top-up depends on how far the design has progressed. At the earliest stage — nought to ten per cent designed — it is 64 per cent.

    ALTO’s cost estimate is described in its own report as an AACE Class 5 estimate, which is the earliest and least developed class there is. Applied as the manual directs, a cost of $60 to $90 billion would enter the comparison at roughly $98 to $148 billion, before any comparison with benefits is attempted. That range is our own arithmetic on ALTO’s published estimate at the manual’s stated uplift; ALTO publishes no uplifted figure.

    The report applies no such adjustment and does not mention the concept. It is worth noting where this reasoning comes from: the manual grounds the adjustment in the research on transport megaproject cost overruns that this Initiative has drawn on since its first publication. That reasoning is already embedded in the appraisal manual ALTO chose to cite.

    The Central Inversion

    Too early to divide, but not too early to multiply

    The report declines to publish a benefit-cost ratio — benefits divided by costs, the single number a reader would most want. Its stated reason is that the cost estimate is too immature to support one.

    Under the framework ALTO cites, that reasoning runs backwards. The manual sets out what is required at each stage of a project’s life. At the earliest stage, the very stage ALTO is at, the requirement is a single line: conduct sensitivity testing to understand the key drivers and the level of uncertainty in each option.

    Early-stage uncertainty is not an exemption from testing. It is the reason testing is required. The report treats it the other way round: immaturity on the cost side is given as grounds for publishing nothing, while single-point figures are published on the benefit side of the same ledger. The same uncertainty is treated as decisive for one number and immaterial for the other.

    And a business case for this corridor has already done it. In December 2021 the Joint Project Office — VIA Rail and the Canada Infrastructure Bank — published a benefit-cost ratio for High Frequency Rail, the cheaper predecessor to ALTO, at a comparable stage of development: about 0.13, or roughly 0.4 on an expanded basis counting fare revenue and agglomeration as benefits. It published a net present value of minus $21.1 billion and a thirty-year public subsidy of $37.1 to $42.2 billion alongside it. Its economic parameters were drawn from Metrolinx and Ministère des Transports du Québec guidance — the same two sources ALTO cites. Immaturity did not prevent a ratio then. The companion explainer Hours Are Not Dollars sets out those figures in full, including why 0.13 rather than 0.4 is the anchor.

    A related point arises elsewhere in the report. In explaining why one set of results is excluded from the welfare account, it refers to those results as therefore not being included in the benefit-cost ratio — speaking of it as a thing with a settled boundary about what enters it. One page says a meaningful ratio cannot yet be produced. Another treats the ratio as already drawn up. The two are difficult to read together, and the report does not reconcile them.

    Limits of This Analysis

    What this brief does not say

    Stated here rather than left for others to find.

    On the analysis

    The rate is not wrong3.5 per cent is a defensible choice, used by the United Kingdom Treasury and by Metrolinx, and well supported for long-horizon public investment. This brief does not argue that ALTO’s rate is too low or too high.
    Metrolinx does not bind ALTOA provincial agency’s manual has no legal force over a federal Crown corporation. The argument is about the coherence of a citation, not about jurisdiction.
    One choice runs in ALTO’s favourThe 3.5 per cent rate is applied flat across sixty years. The UK Treasury, whose Social Time Preference Rate this figure matches, steps its rate down to 3.0 per cent after year 30. Applying that schedule would have made ALTO’s benefit total larger, not smaller.
    One cited source was not reviewedGuidance from the Ministère des Transports du Québec is cited separately for the value of time. The Initiative has not reviewed it and takes no position on what it requires.

    On the report and its source

    The report does apply conservatism in placesAccident reductions are capped after twenty years, and car emission factors are assumed to improve to 2050, which the report notes limits the emissions benefit. These are the two smallest monetised lines. No equivalent constraint is disclosed for travel time, which is 78 per cent of the total.
    The manual itself is datedMetrolinx said in 2021 that a revised version with updated values would follow in 2022. Five years on, it has not. That is a limitation of the source document, not a fault of ALTO’s — but a reader assessing where a federal appraisal input came from is entitled to know it.
    Which figures are whoseEvery figure attributed to ALTO, Metrolinx, the Joint Project Office, HM Treasury or Statistics Canada is quoted from the sources listed below and can be checked there. Three figures are our own arithmetic and are marked as such where they appear: the $98 to $148 billion uplifted capital range, the $21.40 inflation-escalated value of time, and the five per cent effect of the declining Green Book schedule. Where the report does not state something, we say so rather than inferring it, and we make no claim about why any requirement was or was not carried across.
    This is a public report, not a formal submissionA business case submitted to Cabinet in 2029 may well contain material this document does not. The claims examined here are the claims ALTO has chosen to put in public.
    What Would Settle It

    Two questions ALTO can answer without releasing a model

    Both are answerable from work ALTO has already done. Neither requires disclosure of a model, cooperation from staff, or agreement about what the correct discount rate for a national railway ought to be.

    1. Was the calculation ever run at a rate other than 3.5 per cent?

    And if so, what were the results? A negative answer is itself informative — it would mean the required test was never performed. An affirmative answer is the sensitivity table the report does not contain.

    2. Which parts of the cited guidance were applied, and which were departed from?

    The Metrolinx document requires that any variation from its parameters be agreed and clearly justified. The report records no variations at all — while, on the evidence above, departing from several.

    Where Things Stand · August 2026

    Summary ledger

    Measured against the requirements of the manual ALTO names as its authority:

    Carried across
    The 3.5 per cent discount rate, correctly cited to the manual.
    Carried across
    The single blended value of time, expressly justified by reference to the manual.
    Partial
    The thirty-year cap on benefit growth: applied to accident and emissions lines, not stated for travel time, which is 78 per cent of the benefits.
    Partial
    A single price year throughout: the appraisal is in 2024 dollars, the GDP result in 2019 dollars.
    Left behind
    Discount rate sensitivity test at 2.5 per cent.
    Left behind
    Value of time sensitivity test at 0.75 per cent real growth.
    Left behind
    Range analysis of costs and assumptions, reported with a confidence level.
    Left behind
    The probability that benefits exceed costs, and the benefit-cost ratio itself.
    Left behind
    The standard set of performance indicators: net present value, benefit-cost ratio, capital utilisation, return on investment, internal rate of return.
    Left behind
    The optimism-bias top-up on construction costs, 64 per cent at this level of design — not applied and not mentioned.
    Left behind
    The lower end of the range, on figures the report itself labels an upper estimate.

    ALTO names an appraisal manual twice — once for its discount rate, once to justify a single blended value of time — and leaves behind the testing, the ranges, the optimism adjustment and the benefit-cost reporting that the same manual attaches to those figures at this project’s scale. What remains is a column of numbers labelled an upper estimate whose lower estimate is never shown, resting on parameters presented as facts rather than as selections, in a report that declines to divide that column by the cost while describing the benefits as holding across a wide range of scenarios.

    Every document relied on here is public. Nothing in this analysis requires access to ALTO’s models, cooperation from its staff, or a view on what the correct discount rate for a national railway ought to be.

    Download Full Brief
    Two Parameters, None of the Conditions (PDF)
    Full research brief with page references, parameter tables, worked figures and sources
    Download PDF

    If the terms in this brief are unfamiliar — what a discount rate actually does, why a benefit figure is not money, and who ends up paying — the companion explainer Hours Are Not Dollars covers the same ground in plain language, and sets out the 2021 business case figures in full.

    Sources

    Primary documents

    1.
    ALTO, Canada’s Moment: The Economic Opportunity of High-Speed Rail, August 2026, 83 pp. Discount rate, appraisal period and price base in the Appendix A methodology box, sourced at footnote 65 to the Metrolinx Business Case Manual Volume 2; value of time and the single-parameter justification in the same appendix, with Ministère des Transports du Québec guidance at footnote 66. Direct-effects tables headed “upper estimate, $2024 CAD”; benefit-cost ratio discussion at p. 62 and reference to the benefit-cost ratio at p. 80; capital cost and AACE Class 5 at pp. 5 and 65; scenario-robustness claims at pp. 3 and 69.
    2.
    Metrolinx, Business Case Manual Volume 2: Guidance, August 2021, 222 pp. Economic parameters at Table 5.8; sensitivity requirements at Tables 5.1 to 5.3; optimism bias at Tables 5.4 to 5.6; worked range example at Table 5.7; Economic Case lifecycle requirements and key performance indicators; business case principles at pp. 11 and 13; guidance revision cycle at p. 4. metrolinx.com
    3.
    Metrolinx, “Business Cases — Resources,” accessed 21 August 2026. The Business Case Guidance link resolves to the Volume 2 file under an asset version token corresponding to 15 September 2022; no Volume 2 revision has been issued.
    4.
    B. Flyvbjerg, Procedures for Dealing with Optimism Bias in Transport Planning (UK Department for Transport, 2004), cited in the Metrolinx Guidance as the basis for the optimism-bias uplift.
    5.
    Statistics Canada, Table 18-10-0004-01, consumer price index, used for the 2021 to 2024 escalation of the Metrolinx value of time. The comparison is arithmetic and is not an attribution of method.
  • Two point two trillion

    Two Point Two Trillion

    ALTO’s headline economic claim is true of the Canada that existed in 2019. It is presented to the public as today’s.

    ⚠ Two studies, two summaries

    ALTO has commissioned two economic studies and published both. Aviseo Consulting produced a computer model of the effect of high-speed rail on the whole Canadian economy. CPCS, working with HDR, produced a study of its effect on tourism. Both reports are careful. Both state their limits plainly. Both are free to download from ALTO’s website.

    This brief is not about those studies. It is about the difference between what they say and what ALTO says they say. That difference is where the public numbers come from — and it is what a travel trade article repeated to a wide audience on July 20, 2026, without opening either report.

    What we found, in one minute

    The famous 1.1 per cent is 1.1 per cent of Canada’s 2019 economy. The Aviseo report says so on page 13, in those words. ALTO’s public pages drop the year and call the money “today’s value.” Canada’s economy is now about a third bigger than it was in 2019, so the same claim in today’s money would be about $36.5 billion, not $24.5 billion — or, if you keep the dollar figure, about 0.74 per cent, not 1.1.

    Almost all of it is one assumption. Of the $24.4 billion the model produces, $21.0 billion comes from assuming businesses in and around Toronto, Montréal, Ottawa and Québec City become 3 per cent more productive. Change that one dial to 2 per cent and the answer is $13.8 billion. Change it to 5 per cent and it is $34.5 billion. ALTO publishes the middle figure and not the range.

    The two studies disagree with each other about tourism. Aviseo counts international visitors only and says domestic tourism is mostly people spending money they would have spent anyway. CPCS builds its headline on domestic travel within the corridor. The two use different methods that cannot be added together. Neither of ALTO’s summaries mentions the other study.

    And in the tourism study’s base case, the small towns get nothing at all. Under the scenario where no extra tourism policy is put in place, Peterborough and Trois-Rivières receive zero additional visitor spending and zero additional GDP. The blog post announcing that study is titled “How High-Speed Rail Will Boost Tourism from Big Cities to Small Towns.”

    The Arithmetic

    1.1 per cent of which year?

    ALTO’s website puts the claim in one line: a “1.1% increase in Canada’s GDP ($24.5 billion in today’s value)”. GDP means the total size of the economy — everything the country produces in a year.

    Work backwards from those two numbers and you can calculate how big the economy would have to be for both to be right at once.

    $24.4B
    the benefit the study actually reports
    Aviseo report, Table 1
    1.1%
    the share of the economy that represents
    Aviseo report, page 13
    $2.22T
    the size of economy where both are true
    $24.4 billion divided by 1.1 per cent

    Statistics Canada measures the economy every three months. In the first quarter of 2026 it came to $3,321,588 million — about $3.32 trillion. That is roughly $1.1 trillion more than the figure the two numbers imply. Statistics Canada

    Two notes on these figures. Nobody has claimed that Canada’s economy is $2.22 trillion. That number is our own division of the two figures ALTO publishes together, and it is here because it is what those two figures imply about each other. And the benefit appears on this page as both $24.4 billion and $24.5 billion: the first is the number in Aviseo’s own table, the second the rounded form ALTO uses on its benefits page. They are the same estimate.

    The study explains why, and it is not hiding anything. The Aviseo model is built on Statistics Canada’s 2019 picture of the economy, chosen because 2020 and 2021 were pandemic years and the data from them is not reliable. Page 13 then states the result carefully: the gain is about $24.4 billion, which is roughly 1.1 per cent of Canada’s 2019 GDP.

    That is the whole finding. The study says 2019. ALTO’s website says “today’s value.”

    If you use the 1.1 per cent

    Applied to today’s economy, the benefit would be about $36.5 billion a year. ALTO’s published dollar figure understates its own claim by roughly a third.

    If you use the $24.4 billion

    Measured against today’s economy, that is about 0.74 per cent — not 1.1. The headline percentage is too high for the dollar figure beside it.

    There is a further wrinkle worth knowing. The model is what economists call static. It does not project forward year by year. It asks a single question: what would 2019 have looked like if the railway had already been running? The report says so directly. That means there is no discounting and no present-value calculation anywhere in it — so the phrase “in today’s value” describes a piece of arithmetic the study never performed.

    Where The Number Comes From

    Almost all of it is a single dial

    The model adds up three separate effects. The report breaks them out, so we can see exactly how much each one contributes to the $24.4 billion.

    ChannelContributionShare of total
    Productivity — businesses getting more done because cities are better connected$21.0B86%
    Labour supply — people working more hours because commuting is quicker$2.7B11%
    Tourism — extra spending by international visitors$0.8B3%
    Total$24.4B100%

    Nearly nine tenths of the headline comes from the productivity line. So it is worth knowing exactly how that number was produced.

    The modellers picked a figure from the international research for how much more productive businesses become when a fast rail link arrives. The research offers a range. They chose 3 per cent for their middle case, then applied it to the economies of four metropolitan areas: Toronto, Montréal, Ottawa and Québec City.

    Those four metros produce roughly a third of Canada’s economy. Three per cent of a third is about one per cent. The headline is close to being arithmetic from the assumption rather than a discovery about railways.

    What happens when you move the dial

    The report tests three settings. At 2 per cent, the total is about $13.8 billion. At 3 per cent, it is $24.4 billion. At 5 per cent, it is $34.5 billion. Across everything the report tests, the full range runs from $14.8 billion to $41.0 billion. ALTO’s blog post and website give one number from the middle of that range and no range at all.

    And note which places are in the calculation

    Toronto, Montréal, Ottawa and Québec City. Not Peterborough. Not Trois-Rivières. Not Laval. The model gives the productivity benefit — nearly nine tenths of the whole claim — to the four largest cities on the line and to nowhere else.

    The research the modellers drew on says these effects concentrate within about 30 kilometres of a station. Because nobody knows yet where the stations will be, the study used each city’s whole metropolitan area as a stand-in for that 30-kilometre circle. The report is open about this. It means the 3 per cent boost is applied to every business in those metros, including the great many that will never go near the train.

    Study Versus Summary

    What the reports say, and what the blog posts say

    Both studies are honest about their limits. Both blog posts announcing them are not. This is the pattern at the centre of this brief.

    What the report saysWhat ALTO’s summary says
    Aviseo: the gain is roughly 1.1 per cent of Canada’s 2019 GDP.ALTO’s blog: the analysis concludes ALTO will permanently uplift Canada’s GDP by 1.1 per cent. No year. ALTO’s benefits page: $24.5 billion in today’s value.
    Not carried:The base year
    Aviseo: results run from $14.8B to $41.0B depending on which assumptions are used.One figure, from the middle. The range appears in neither the blog post nor any public ALTO page.
    Not carried:The range
    Aviseo: the study deliberately excludes construction and operating costs, looking only at long-term effects.Presented as the economic case for building the railway. A study that excludes costs cannot tell you whether a project is worth its price.
    Not carried:The scope limit
    CPCS: the scenarios are illustrative, order-of-magnitude, and “should not be interpreted as forecasts.”ALTO’s blog: CPCS developed forecasts, and the report includes tangible projections giving real-world, objective results.
    Contradicted:The report’s own caution
    CPCS: three scenarios — $177M, $1.0B, $3.9B in added GDP, depending on how much tourism policy is coordinated.The middle figure only. The low scenario, roughly six times smaller, is not mentioned.
    Not carried:The low case
    Both reports: commissioned and paid for by ALTO. Aviseo’s cover states the work was undertaken on ALTO’s behalf. CPCS notes the opinions are the authors’ own.Both blog posts describe the consultants as independent — in the same passage that says ALTO engaged them.
    As stated:The word “independent”

    To be clear about who did what

    Neither consultancy has done anything wrong here. Aviseo tested six different sets of economic assumptions and two labour-market conditions, ran close to a hundred simulations, reported ranges throughout, and stated its base year. CPCS labelled its scenarios illustrative and warned against reading them as forecasts. The reports are the careful part. The summaries are where the caution disappears.

    Two Studies, One Question

    The two reports disagree about tourism

    Both studies estimate how much extra economic activity tourism would bring. They arrive at similar-looking numbers by opposite routes, and the two cannot simply be added together or compared.

    Aviseo — $0.8 billionCPCS — $1.0 billion
    Counts international visitors only. The report says domestic tourism is largely people spending money they would have spent somewhere else in Canada anyway, so it has limited effect on the national total.

    Uses a model of the whole economy, which subtracts activity drawn away from elsewhere.
    Its middle scenario is driven mostly by travel within the corridor — exactly the domestic tourism Aviseo set aside.

    Uses a simpler method that adds up ripple effects through suppliers and wages without subtracting what was displaced. This produces larger figures by design.
    Result:Two numbers that cannot be combined

    There is a third figure in circulation. ALTO’s FAQ page advertises $800 million a year in tourism revenue. That matches Aviseo’s contribution-to-GDP figure, which is not the same thing as revenue — and it matches no revenue figure in either report.

    So ALTO’s public materials carry a tourism benefit that is variously $0.8 billion of national output, $1.0 billion of national output, and $800 million of revenue, drawn from two studies using incompatible methods, one of which discounts the category the other relies on. Neither blog post mentions that the other study exists.

    The Small Towns

    In the base case, two station cities get zero

    The CPCS tourism study models three futures. The railway is identical in all three. What differs is how much extra tourism policy governments put in place around it — last-mile transit, regional shuttles, coordinated visitor information. The low coordination scenario is the one where the railway gets built and nothing else changes.

    CityLow coordinationHigh coordination
    Toronto$37Mup to $1,500M
    Québec City$50Mup to $500M
    Montréal (incl. Laval)$44Mup to $900M
    Ottawa-Gatineau$21Mup to $560M
    Trois-Rivières$0up to $25M
    Peterborough$0up to $35M

    Zero. Not a small amount — nothing. The report’s GDP table records the same: Peterborough unchanged at $475 million, Trois-Rivières unchanged at $318 million.

    Even under full corridor-wide coordination, Peterborough reaches up to $35 million against Toronto’s $1.5 billion — roughly 43 to 1. The blog post announcing this study is titled “How High-Speed Rail Will Boost Tourism from Big Cities to Small Towns.”

    The Initiative has examined this study in full elsewhere — its scope, the conditions attached to its scenarios, the rural corridor regions left outside its frame, and the cost side it does not count. Benefits for Stations, Costs for the Corridor

    The Missing Side

    A study that cannot tell you if it is worth it

    The Aviseo report states in its introduction that it deliberately leaves out construction and operating costs, in order to focus on long-term effects. That is a reasonable choice for the study. It has a consequence.

    A benefit figure with no cost beside it cannot answer the only question that matters: is this worth building? The report never claims to answer it. ALTO’s summary presents it as though it does, and the trade coverage went further still, running the entire economic case without a single dollar of cost anywhere in it.

    The cost side is not a mystery. It is simply somewhere else. ALTO’s published figure is $60 to $90 billion — a range its own chief executive has described as a working assumption rather than an estimate, with real numbers not expected until 2027 or 2028, after the route is chosen. The Initiative’s analysis of the full ledger puts ALTO’s central benefit-cost ratio at about 0.11, against the 1.0 that marks a project paying its way. Financial Analysis

    The shape of the published record

    The benefit is modelled in detail by two consultancies, published to two significant figures, and repeated by every outlet covering the project. The cost is a range spanning $30 billion, described by the proponent as an assumption, and resolvable only after the decision it is meant to inform has been taken. That asymmetry is the finding, not the individual numbers.

    This is the pattern the Oxford researcher Bent Flyvbjerg documents across large infrastructure projects worldwide: benefits arrive early, precisely, and in dollars; costs arrive late, as ranges, after commitment.

    The Chain

    Six weeks, and the reports were not cited

    The article that prompted this brief promised readers what others are missing about ALTO’s economics, and led on tourism. Here is what had already been published.

    2019
    The year of the economy the Aviseo model is built on. Everything downstream is expressed in this year’s terms.
    2024
    Aviseo runs the model. ALTO supplies its passenger forecasts in May and June.
    June 8, 2026
    ALTO publishes “How High-Speed Rail Will Boost Tourism from Big Cities to Small Towns,” with the full CPCS tourism report attached for download.
    June 2026
    The Aviseo report is uploaded to ALTO’s website.
    July 13, 2026
    ALTO publishes “How Alto Will Reshape Canada’s Economy,” with the full Aviseo report attached for download. It states the 1.1 per cent without the year, the range, or the cost exclusion.
    July 20, 2026
    A travel trade site publishes a long article on ALTO’s economics and tourism benefits under a headline promising what others are missing. Its two themes are the two blog posts. It cites neither report, calls the analysis independent, and contains no cost figure of any kind.

    Seven days after one blog post and six weeks after the other. The tourism angle presented as the overlooked discovery had been the subject of an entire ALTO blog post and a 42-page commissioned report, both freely available, for a month and a half.

    Why this matters more than one bad article

    Each outlet in a chain like this can be cited by the next as confirmation. A figure that has never been independently checked ends up looking like something everybody agrees on, purely because it has been repeated. In this case the answer was not hidden. It was a click away from the two blog posts the article’s themes are drawn from.

    What the article contains, and what it does not

    The article cites neither report. It describes the analysis as independent. It contains no cost figure of any kind. Its two themes are the subjects of two ALTO blog posts published seven days and six weeks earlier, each with the full commissioned report attached for download on the same page.

    Summary · July 2026

    Where things stand

    Wrong year
    “$24.5 billion in today’s value.” The study says 1.1 per cent of Canada’s 2019 GDP. In today’s economy the same claim is either $36.5 billion or 0.74 per cent, not $24.5 billion and 1.1 per cent.
    Wrong kind
    “Today’s value” describes a calculation the study never did. The model is static and contains no discounting. Its results are annual, not a one-time total.
    Not carried
    The range. Aviseo reports $14.8B to $41.0B. CPCS reports $177M, $1.0B and $3.9B. ALTO publishes one figure from the middle of each.
    Not carried
    The scope limit. Aviseo excludes costs by design. The study is presented as the economic case for a project whose price it never considered.
    Contradicted
    “Should not be interpreted as forecasts.” CPCS’s words. ALTO’s summary calls the same scenarios forecasts, tangible projections and objective results.
    At odds
    Benefits for small towns. Under the scenario where only the railway is built, Peterborough and Trois-Rivières receive $0. The blog announcing that report is titled “from Big Cities to Small Towns.”
    Unreconciled
    Two tourism figures. $0.8B from one study counting international visitors, $1.0B from another counting domestic travel, by methods that cannot be combined — plus $800M of “revenue” on the FAQ that matches neither.
    As stated
    “Independent.” Both consultancies were engaged and paid by ALTO. Both blog posts state this in the same passage that calls the firms independent, so a reader who takes the word to mean “not commissioned by the proponent” is reading it in a sense the passage itself rules out.
    Fragile
    Eighty-six per cent of the claim rests on one assumption — a 3 per cent productivity gain applied to four metropolitan economies. At 2 per cent the total is $13.8B; at 5 per cent, $34.5B.
    Sound
    The studies themselves. Both are careful, both state their limits, both are published in full and free to download. Our argument is with the summaries, not the analysis.

    What we are and are not saying

    We are not saying high-speed rail cannot bring economic benefits, and we are not criticising the consultants who did this work.

    We are saying that ALTO commissioned two careful studies and then published summaries that removed the base year, the ranges, the scope limits and the warnings — and that the resulting figures now circulate as settled facts. On the arithmetic, the position is narrow and easy to check: 1.1 per cent and $24.5 billion cannot both describe today’s Canada, and the study says which year they describe.

    ALTO could correct this in a sentence. Adding the words “of 2019 GDP” to its benefits page would make the claim accurate.

    How to read the numbers on this page

    Every figure attributed to Aviseo, CPCS, ALTO or Statistics Canada is quoted from the source listed below and can be checked there. Every other figure is our own calculation from those published inputs: the $2.22 trillion implied economy, the $36.5 billion and 0.74 per cent restatements in current terms, the observation that 3 per cent of roughly a third of national output is about 1 per cent, the 43-to-1 Toronto-to-Peterborough ratio, and the benefit-cost ratio of about 0.11, which comes from our own financial analysis and not from either commissioned study.

    Where a study or a summary does not state something, we say so rather than inferring it, and we make no claim about why any particular qualification was or was not reproduced.

    Download
    Two Point Two Trillion — Full Brief (PDF)
    The complete analysis, with all figures, tables and sources
    Download PDF
    Sources

    Where our figures come from

    1.Aviseo Consulting, An Overview of the Structural Economic Impacts of Alto: Computable General Equilibrium Modelling Approach, June 2026. Prepared on behalf of ALTO. Source of the 2019 calibration, the $24.4 billion figure, the 1.1 per cent of 2019 GDP statement (page 13), the $14.8B–$41.0B range, the channel breakdown, and the productivity settings of 0.02, 0.03 and 0.05. altotrain.ca (PDF)
    2.ALTO, “How Alto Will Reshape Canada’s Economy,” blog post, July 13, 2026. States the 1.1 per cent without the base year or range, and describes the commissioned report as independent. Links the Aviseo report. altotrain.ca
    3.CPCS, in association with HDR, Tourism in the Alto Corridor: Current Conditions and Potential Impacts, June 2026. Prepared for ALTO. Source of the three coordination scenarios, the per-city spending and GDP tables, the statement that the scenarios should not be interpreted as forecasts, and the finding on business spending declines. altotrain.ca (PDF)
    4.ALTO, “How High-Speed Rail Will Boost Tourism from Big Cities to Small Towns,” blog post, June 8, 2026. Reports the medium scenario only, and describes the scenarios as forecasts and tangible projections. Links the CPCS report. altotrain.ca
    5.ALTO, “Discover Alto’s Many Benefits,” project benefits page. Source of the “$24.5 billion in today’s value” phrasing and the construction and operational jobs figures. altotrain.ca
    6.ALTO, “Answering your questions.” Source of the $800 million annual tourism revenue claim. altotrain.ca
    7.Statistics Canada, Gross domestic product, income and expenditure, first quarter 2026, released May 29, 2026. Table 1 gives gross domestic product at market prices, seasonally adjusted at annual rates, of $3,321,588 million for the first quarter of 2026. Underlying series: Table 36-10-0103-01. Table 1  ·  Table 36-10-0103-01
    8.Rituparna Dutta Choudhury, “Canada’s Toronto–Québec City High-Speed Rail Could Unlock GDP Growth: What Others Are Missing About Alto’s Billion Dollar Economic Transformation,” Travel and Tour World, July 20, 2026. travelandtourworld.com
    9.ALTO HSR Citizen Research Initiative, ALTO Financial Analysis. Source of the benefit-cost ratio of approximately 0.11, the cost-per-kilometre model, and the achievable ridership frontier of 5 to 12 million annual trips against ALTO’s 24 million target. citizenresearch.ca
    10.ALTO HSR Citizen Research Initiative, Tourism Study brief, June 2026. Examines the scope of the CPCS study, including the exclusion of rural corridor regions. citizenresearch.ca
    11.Bent Flyvbjerg, on optimism bias and reference-class forecasting in the appraisal of large infrastructure projects.
  • The more you look

    The More You Look, the Worse It Gets — ALTO HSR Citizen Research Initiative

    The More You Look, the Worse It Gets

    Thirty studies of high-speed rail in this corridor, across fifty-six years. One simple pattern runs through all of them.

    ⚠ The bottom line, up front

    The people building the railway say it will pay for itself. The one independent study in 2026 that actually checked the math — using the builders’ own cost estimates — found a hole of about $53 billion over fifty years.

    That’s not a fluke. It’s the pattern. For fifty-six years, the case for this railway has looked best in exactly the studies with the most to gain from building it.

    In one minute

    We read thirty major studies of high-speed rail in this corridor, from 1970 to today, and asked every one the same set of questions — with all the dollar figures put on a level footing.

    The verdict almost always matches who paid for the study. Equipment makers, the proponent and paid advocates say build it. Independent governments say wait. And every single study that actually runs the finances finds the same thing: ticket sales can’t cover the cost, so the public pays most of the bill.

    The numbers that look great — low costs, huge ridership, big climate wins — come from the promoters. The numbers that survive an independent look are far more sober. The closer and more independent the analysis, the weaker the case.

    Read the full report
    Corridor Rail Studies, 1970–2026 — A Cross-Decade Analysis
    Thirty studies, thirty-four dimensions, nine findings, with the full evidence tables
    Download PDF
    How we know

    Thirty studies. Same questions. Fifty-six years.

    We didn’t cherry-pick. We took thirty of the major studies of this railway — going right back to a 1970 federal commission — and put the same 34 questions to all of them, so the answers line up side by side across the decades.

    30
    major studies of this railway, read into one matrix
    1970–2026
    34
    questions asked of every single study
    so the answers compare
    56
    years of studies, all priced in today’s dollars
    a level playing field

    The studies come from every side: equipment makers, government task forces, a Crown corporation, universities, Transport Canada, and the builders themselves. That range is the whole point — it lets us tell a real change in the corridor apart from a change in who’s doing the asking.

    What we found

    Nine things every reader should know

    Read across all thirty studies, nine patterns keep showing up. Here they are in plain terms.

    1The answer depends on who paid for the study

    Line up the verdicts and it’s impossible to miss. The build-it studies come from equipment makers, from a Crown corporation that wanted to run the trains, from the proponent, and from paid advocates. Every independent government that looked said wait. Building new is the sponsors’ answer — not what fifty-six years of evidence actually points to.

    2It has never paid for itself. Not once.

    Every study that runs the money lands in the same spot: fares can’t cover the cost, and taxpayers foot most of the bill. VIA’s own 1984 numbers came out negative. In 1995, three governments agreed the public would cover 70–75%. In 2026, an independent model put the public subsidy at about $53 billion over fifty years — and found the railway wouldn’t even break even until year 44. The promise that it’ll fund itself is the single most optimistic claim in the whole record.

    3The closer you look, the more it costs

    Whenever a promoter and an independent body price the same thing, the promoter’s number is lower — and the price climbs as the estimate gets more serious. A 2026 advocacy paper gets the cost down to $63 billion only by assuming rock-bottom construction prices, about a third of our own central estimate of roughly $143 million per kilometre. The cheaper the headline, the thinner the math underneath it.

    4The ridership numbers don’t hold up

    The passenger forecasts are shakier than they look — and academics, an airline, Parliament and Transport Canada have all said so. One 1994 study showed the forecast could swing fivefold just by changing a single modelling choice, on the same data. Transport Canada’s own reviewers called the assumptions “optimistic and aggressive.” And the biggest numbers always belong to the promoters.

    5The freight idea is good — with one catch

    Splitting passengers and freight onto the corridor’s two parallel tracks, and freeing up freight capacity as a bonus, is a genuinely sound idea — it was proposed back in 2002. The catch: at the time, the freight railways said they didn’t need the extra capacity. It’s a strong argument, as long as it’s honest about that condition.

    6Going faster barely helps

    Study after study finds that top speed buys almost no extra riders — one found just an 8% jump going all the way from 300 to 400 km/h, another only about 9% from 200 to 300. So the level-headed studies settle far lower: a 2002 plan judged 240 km/h fast enough, and even the independent 2026 model assumes trains averaging just 200–250 km/h. The “top speed everywhere” designs are the outliers — a moderate railway of roughly 180–240 km/h carries nearly the same riders for far less money, and that’s where the evidence actually sits.

    7We’ve seen this financing risk before

    Having a private partner build and run the railway while the public owns the assets isn’t new — and neither is the warning. Both Parliament (1998) and Transport Canada (2003) flagged the same danger decades ago: deals like this can hand the risk to taxpayers and the reward to investors, with a rosy headline resting on one convenient assumption.

    8The climate math only counts the good half

    For decades, no study counted carbon at all. Now they do — but only the savings from getting people out of cars and planes. The huge emissions from pouring hundreds of kilometres of concrete and steel and clearing land? Left out. Count both sides honestly and this design adds emissions for decades. That’s the difference between a climate win and a climate cost.

    9When the numbers fail, out comes “nation-building”

    There’s a move that shows up again and again: when the dollars-and-cents case comes up short, in come national unity, regional growth, and keeping up with other countries. One 2016 report recommended extending the line even at a benefit-cost ratio of 0.24 — about 24 cents of benefit for every dollar spent. These arguments can be fair. But they do the heaviest lifting exactly where the economics are weakest.

    The gap, side by side

    What the promoters say vs. what independent studies find

    All nine findings come down to one contrast. Same railway, same engineering — but the promoters’ numbers and the independent record split apart at every point that matters, and they split the same way every time.

    What the promoters sayWhat independent studies find
    Build it new. Equipment makers, a Crown corporation that wanted the contract, the proponent, and paid advocates all say go ahead. Wait. Every independent government that studied it held off; the reviews and the airlines said upgrade what’s there instead.
    The verdict:Build  vs  Wait
    It’ll pay for itself. The 2025 prospectus says the trains will turn a profit — the rosiest claim in fifty-six years. Taxpayers pay most of it. From 1984 to 2026, every study that runs the money says fares can’t cover the cost. The 2026 independent model: about $53 billion in public subsidy over fifty years.
    The money:Self-funding  vs  ~$53B public
    As low as $63 billion. A 2026 paper reaches that number by assuming bargain construction prices. More like $80–90 billion. The proponent’s own range tops out at $90 billion; independent build-ups land near $80 billion. Costs rise the closer you look.
    Price tag:~$63B  vs  ~$80–90B
    24 to 56 million riders. The 2025–2026 figures are the highest ever produced for this line. About half that. The only recent independent, survey-based forecast lands near 10 million a year — right in line with fifty years of history.
    Yearly riders:~24–56M  vs  ~10M
    A big climate win. The proponent headlines a 39-megatonne cut — counting only the savings from fewer car and plane trips. A climate cost, for decades. The emissions from building it — concrete, steel, cleared land — are left out entirely. Count both sides and it adds emissions.
    On carbon:Half the ledger  vs  The whole ledger
    Ridership

    Same railway. Forecasts from 6 million to 56 million.

    Put the passenger forecasts next to each other and they span almost tenfold — for one railway line. The high numbers always come from the promoters. The one to trust is the recent independent forecast built on an actual survey of travellers.

    ~10M
    independent, survey-based forecast for 2050
    McGill, 2026
    24–43M
    the proponent’s own forecast
    ALTO prospectus, 2025
    42–56M
    the highest numbers ever produced for this line
    2026 advocacy paper
    Study (year)Who produced itYearly ridersBasis
    Air Canada / CP (1993)Airline / railway5.8 Mthe low end of the record
    Task Force (1991)Governments7.8 Mfull corridor
    Tri-government (1995)Governments10–12 Mfull corridor
    EcoTrain (2011)Governments10–11 Mfull corridor
    Lynx (1998)Private consortium11.1 MQuébec City–Toronto
    SNCF (2010)Equipment makerup to 22.5 Mbest-case scenario
    ALTO prospectus (2025)Proponent24–43 Mfull network
    Advocacy paper (2026)Paid advocacy42–56 Mthe highest ever
    McGill (2026)Independent~10 Msurvey-based, 2050

    The numbers aren’t perfectly apples-to-apples — they cover different routes and years — which is part of the point. The takeaway is simple: the independent, survey-based forecast is about half the proponent’s.

    What it means

    Five takeaways

    The current project sits right at the meeting point of every pattern above. The prospectus is the most upbeat sales pitch in the whole record. The most careful independent 2026 work finds a multi-billion-dollar hole. And the one favourable outside verdict is reached only by pairing the cheapest possible construction cost with the highest ridership ever forecast for the line. Here’s what that adds up to.

    What the record points to

    Building new from scratch is the sponsors’ pick, not the safe reading of history. Fifty-six years of evidence leans toward upgrading what exists — or waiting for a full, honest costing.
    Expect the public to pay most of it. Three governments said 70–75% back in 1995, and every financial study since has landed in the same place.
    A moderate-speed, lower-cost railway fits the evidence better. Extra speed barely adds riders, and costs balloon the closer you look. Both have been true for decades.

    What to insist on

    Get the ridership numbers independently checked before trusting them. A single forecast from the people who want to build it isn’t enough — the best studies in the record always used more than one independent forecaster.
    Make the freight case — but be upfront about the catch. The idea is sound; its real value depends on the freight railways actually wanting the freed-up capacity. Say so plainly.
    The evidence

    All thirty studies, at a glance

    Here’s the whole set, oldest to newest. Read the two right-hand columns together — who did the study, and what they concluded — and Finding 1 jumps out: the “build it” verdicts belong to the sellers and the promoters; the governments that were truly independent said wait.

    YearStudy — who did itIndependent of the builder?Verdict
    1970Intercity Passenger Transport Study — CTCFederalUpgrade
    1984High-Speed Passenger Rail in Canada — VIACrown corpMixed
    1990Review of Previous Studies — TRANSURBConsultantWait
    1990A Pragmatic Approach (SPRINTOR) — ABBEquipment makerUpgrade
    1990The Canadian TGV Project — Bombardier / GEC AlsthomEquipment makerBuild new
    1991Rapid Train Task Force — Ontario / QuébecGovernmentsWait
    1991Competition in Rail Carriage — BerkowitzAcademicBuild new
    1992FAST TRACKS — VIA (advocacy)Crown corpBuild new
    1993HST Market Assessment — Air Canada / CPAirline / railwayUpgrade
    1994Demand-model re-estimate — Gaudry & Le LeyzourAcademicNo verdict
    1995Industrial Strategy (Vol II) — Simpson-GuerinConsultantNo verdict
    1995Routing & Costing Study — SNC-Lavalin / DelcanConsultantNo verdict
    1995Québec–Ontario HSR, Final Report — tri-govGovernmentsWait
    1998The Lynx Proposal — Lynx consortiumPrivate consortiumBuild new
    2002VIAFast — VIA RailCrown corpUpgrade
    2003VIAFast validation — IBI for Transport CanadaGov’t reviewerNo verdict
    2009Infrastructure and the Economy — Martin Prosperity Inst.AcademicBuild new
    2010Socio-Economic Study of HSR — SNCFEquipment makerBuild new
    2011Updated Feasibility (EcoTrain) — tri-governmentGovernmentsWait
    2014Toronto–Kitchener–London HSR — SchabasConsultantBuild new
    2015Future of Passenger Rail — Library of ParliamentParliament / indep.Upgrade
    2016Preliminary Business Case — SDG (Steer)ConsultantBuild new
    2016High Speed Rail in Ontario — Special AdvisorProvincialBuild new
    2021Toronto–Montreal Analysis — Munk SchoolAcademicBuild new
    2022Speed and Frequency — AlstomEquipment makerBuild new
    2025All Aboard — C.D. Howe InstituteAdvocacyBuild new
    2025Fast Forward — ALTO (the proponent)ProponentBuild new
    2026Conceptual Design & Business Case — SchabasAdvocacyBuild new
    2026Corridorwide Survey & Financial Analysis — McGillAcademicNo verdict
    2026Eastern Ontario Route (Hwy 401) — Schabas & AntinucciAdvocacyBuild new

    “Advocacy” means a document written to argue a case — a sales prospectus, a think-tank brief, or paid expert advocacy. “No verdict” means the study analysed the question but didn’t take a build/don’t-build position.

    The independent studies to trust

    Where the sober numbers come from

    The full list is above. If you read just a few, read the independent ones — the counterweight to the sales pitch.

    1.
    Québec–Ontario High Speed Rail Project, Final Report — three governments together, 1995. Concluded the public would cover 70–75% of the cost, and a private-only version couldn’t be financed.
    2.
    VIAFast validation — IBI Group for Transport Canada, 2003. The government’s own reviewers, who flagged “optimistic and aggressive” ridership assumptions.
    3.
    Updated Feasibility Study (EcoTrain) — three governments, 2011. The most recent independent-government study; it said wait.
    4.
    Future of Passenger Rail in Canada — Library of Parliament, 2015. Recommended upgrading service rather than building new.
    5.
    Corridorwide Survey & Financial Analysis — Transportation Research at McGill, 2026. The independent study behind the $53-billion subsidy figure and the ~10-million ridership forecast.
